Building Project Update for 6/16/2026
Just in case you missed it... construction is underway!
Upcoming Activity
Work kicked-off this week on the back construction entrance. Demolition is underway. The temporary wall in the sanctuary is already built and should be painted by Sunday.

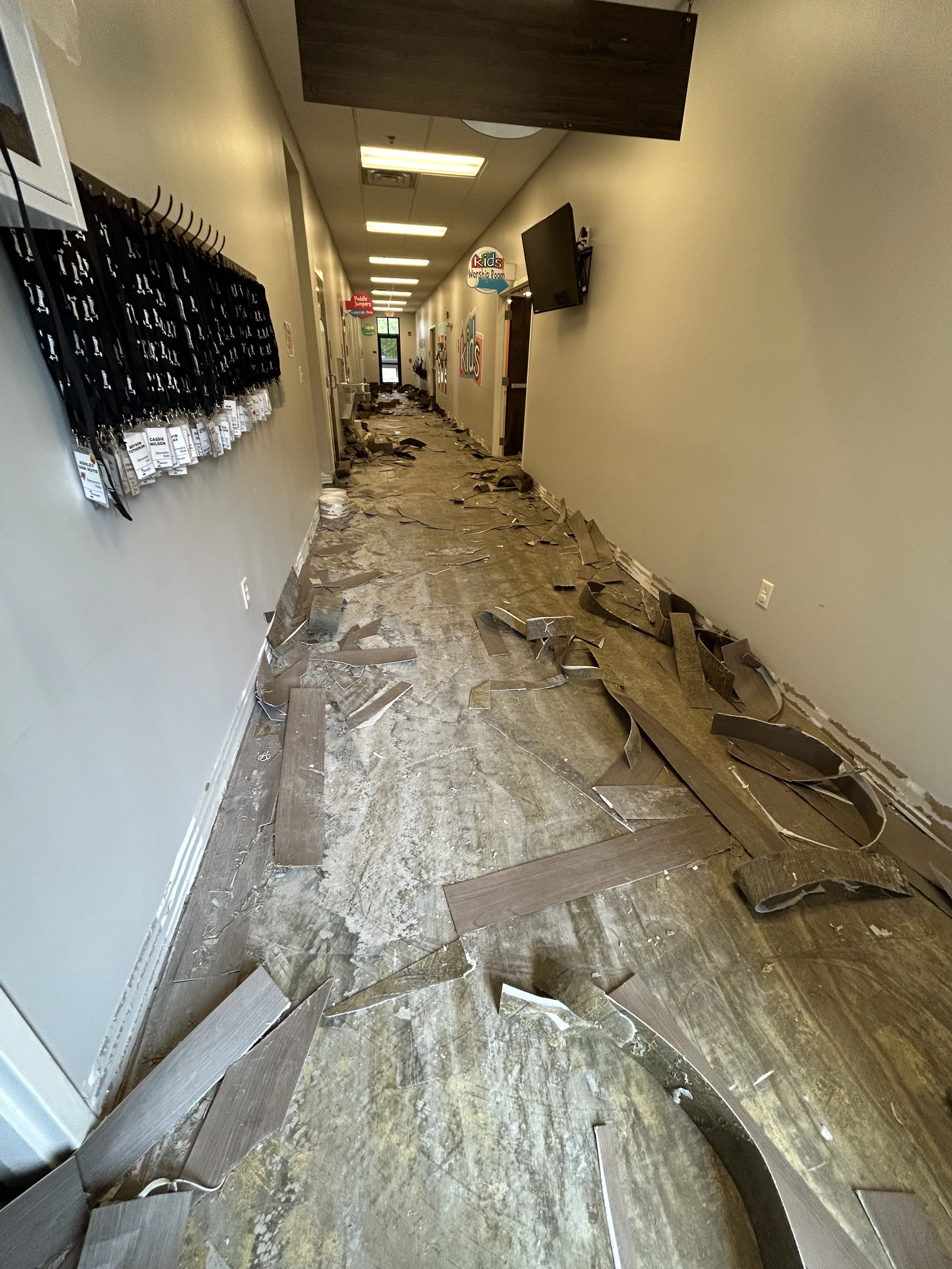

Work has begun in the Kid's expansion area. The flooring has already been removed and concrete grinding will start this week.
Framing is expected to begin early next week.
Ceilings are being opened up for the installation of large water supply pipes and 16 electrical conduits. The original kid's hallway already has most of the ceiling removed and that will stay that way until that area has been remodeled.
DONE!
Building "B" has been completed and has fully cured. Building "A" was poured on 6/12 and will be curing through 6/18.
Now the that slabs are poured it is time to get ready to erect the steel skeleton of buildings A & B. At the end of this week we can expect the steel contractor to be onsite to organize the stacks of steel parts in preparation for installing it.
Steel will not start this week but once it does start you will start seeing something building shaped quickly!
Holding for engineering clarifications.
The primary focus has been removing old wiring above the ceiling and prep work for relocating the security suite.
Last Week's Activity
6/8/2026 through 6/12/2026
Concrete contractor continued with the preparation of slab “A”. Installed edge
forms, rebar and stone. (5 men).
The electrician finished with the underslab rough-in and supervised the stone installation to make sure nothing was damaged. (1 man)
Received a ¼ “ of rain at the end of the day. It didn’t affect work.
Electrical, Plumbing, Steel Erector, Concrete, and Grading contractors were onsite for
Safety/Alignment meeting, along with representatives from the church. We discussed

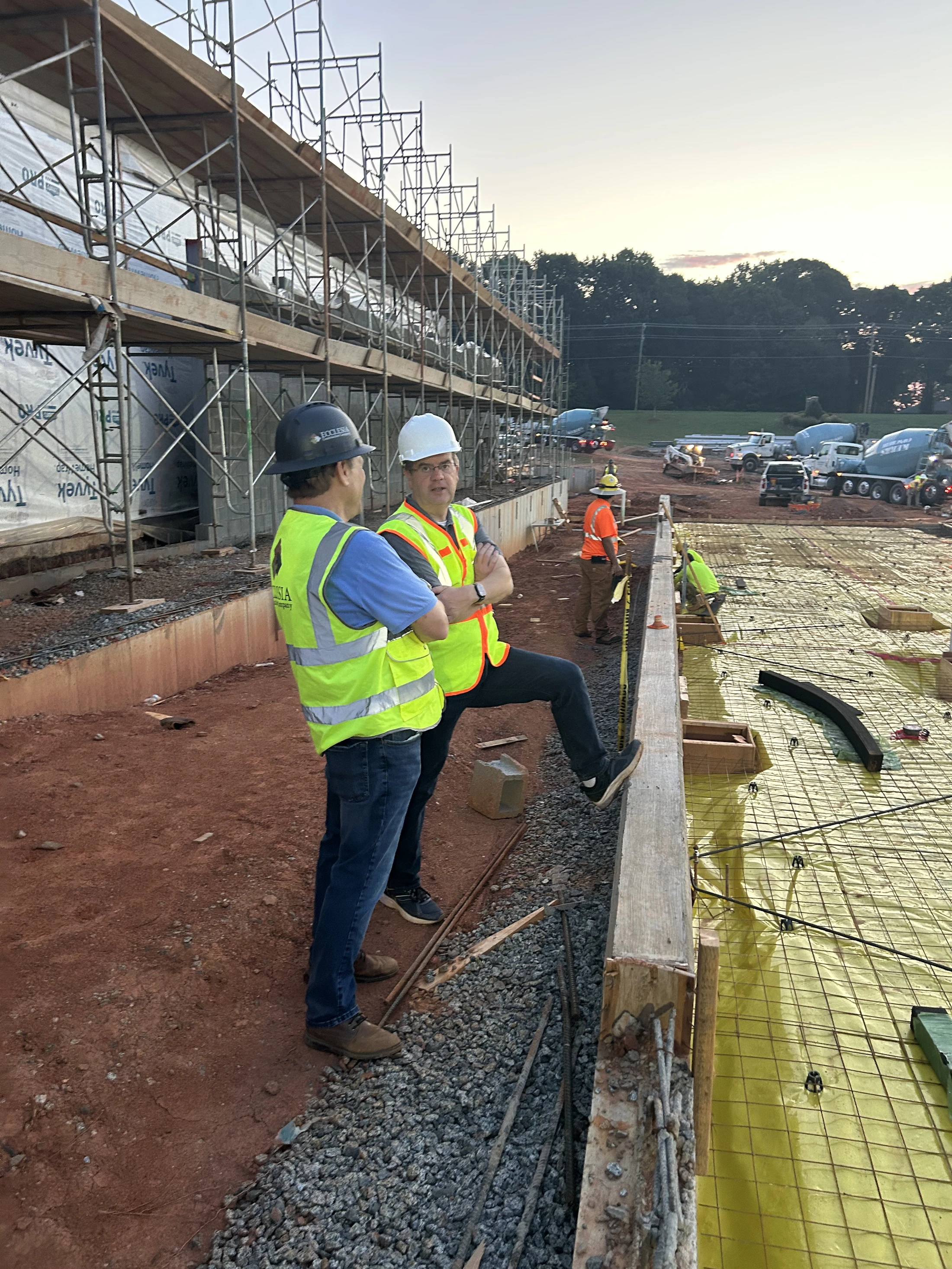

the current schedule for slab pour, along with the current status of the project.
Grading contractor removed asphalt and concrete sidewalk behind and beside building “B”.
The weather is slightly overcast with drizzle throughout the day. No accumulation.
The concrete contractor continued to install poly, wire mesh, and perimeter form board. They also installed anchor rods. (10 men)
Weather was overcast but no rain.
Concrete contractor finished with slab prep (5 men).
County and Special inspectors approved for pour on Friday.

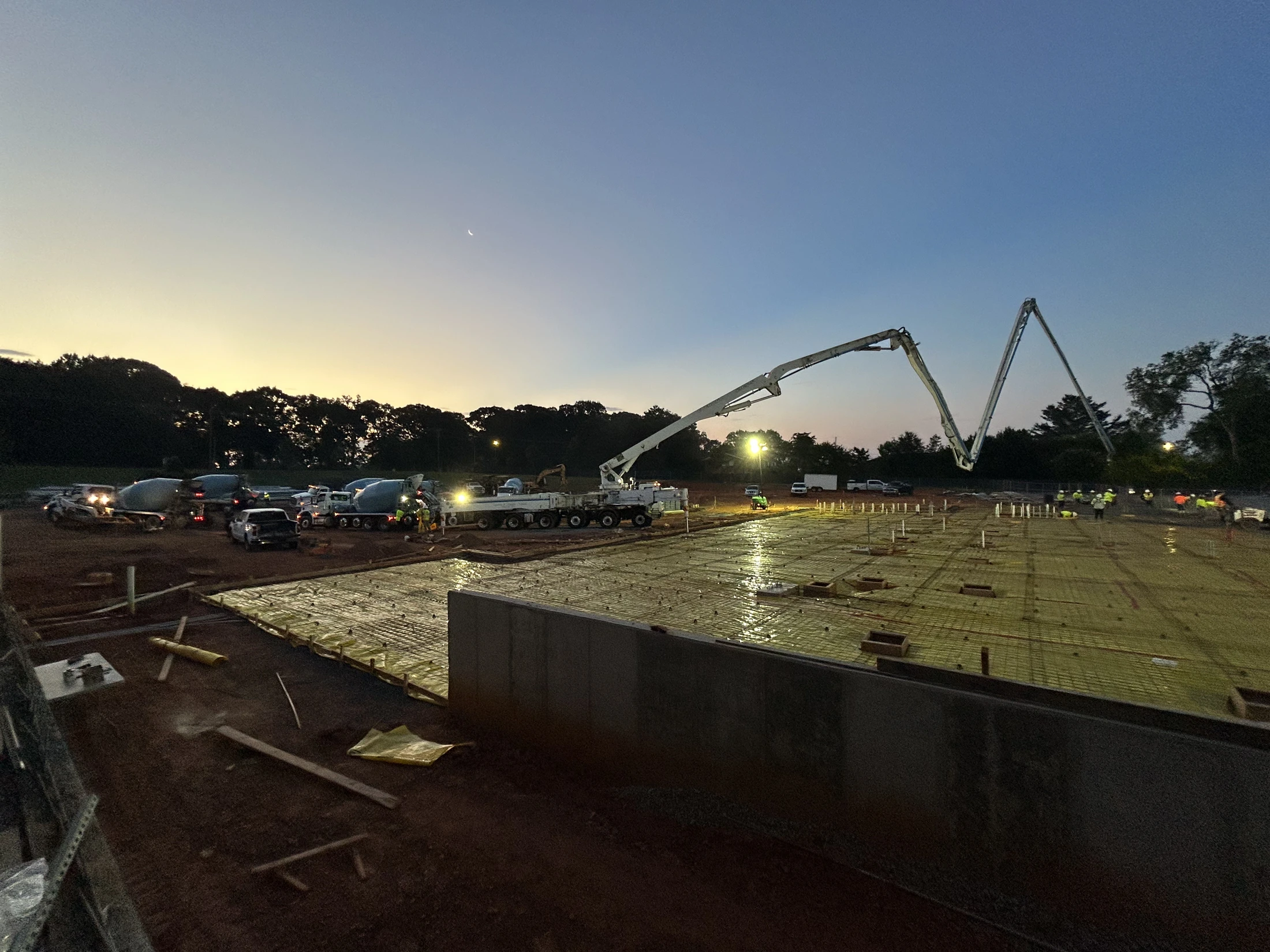

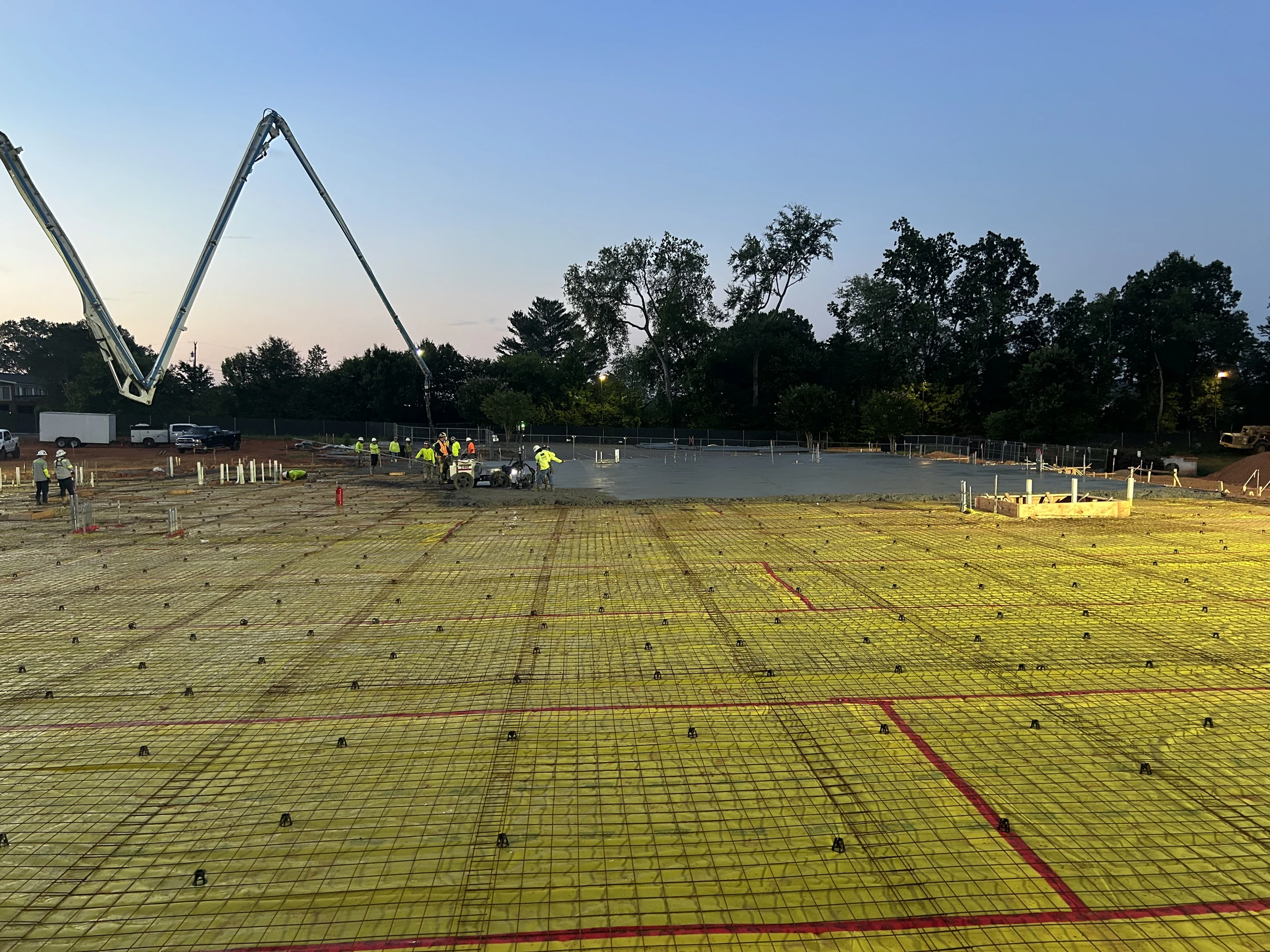

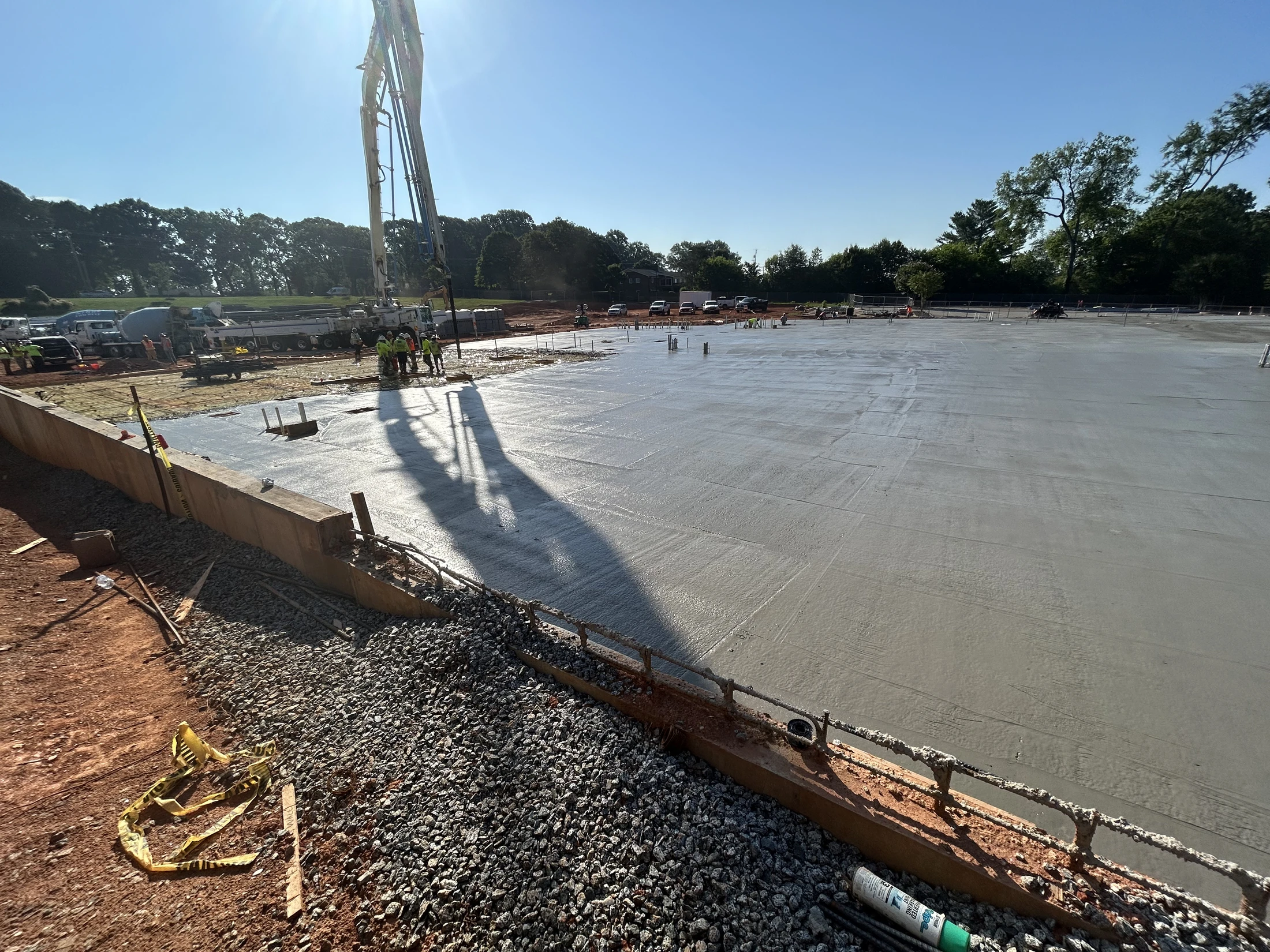

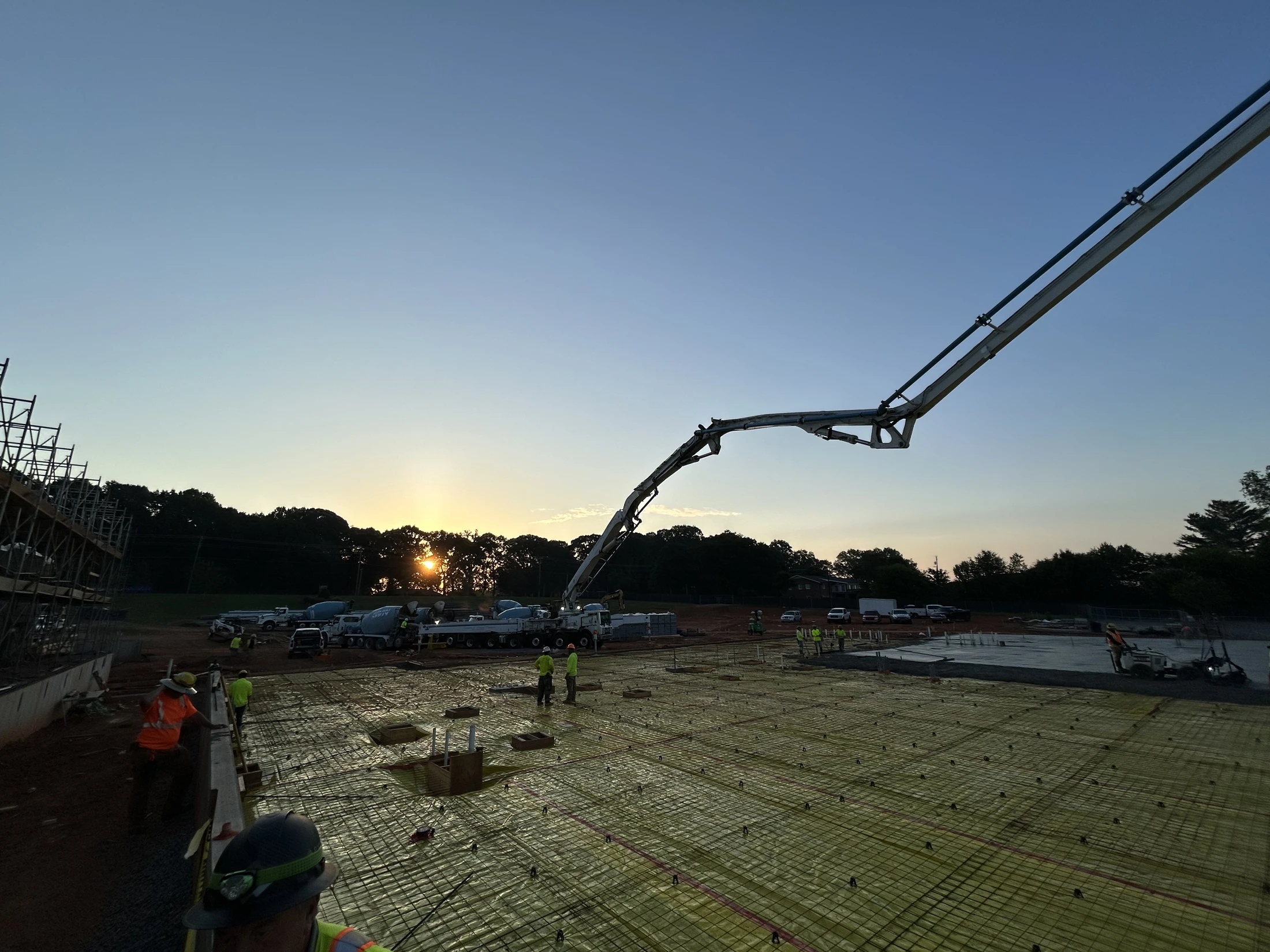

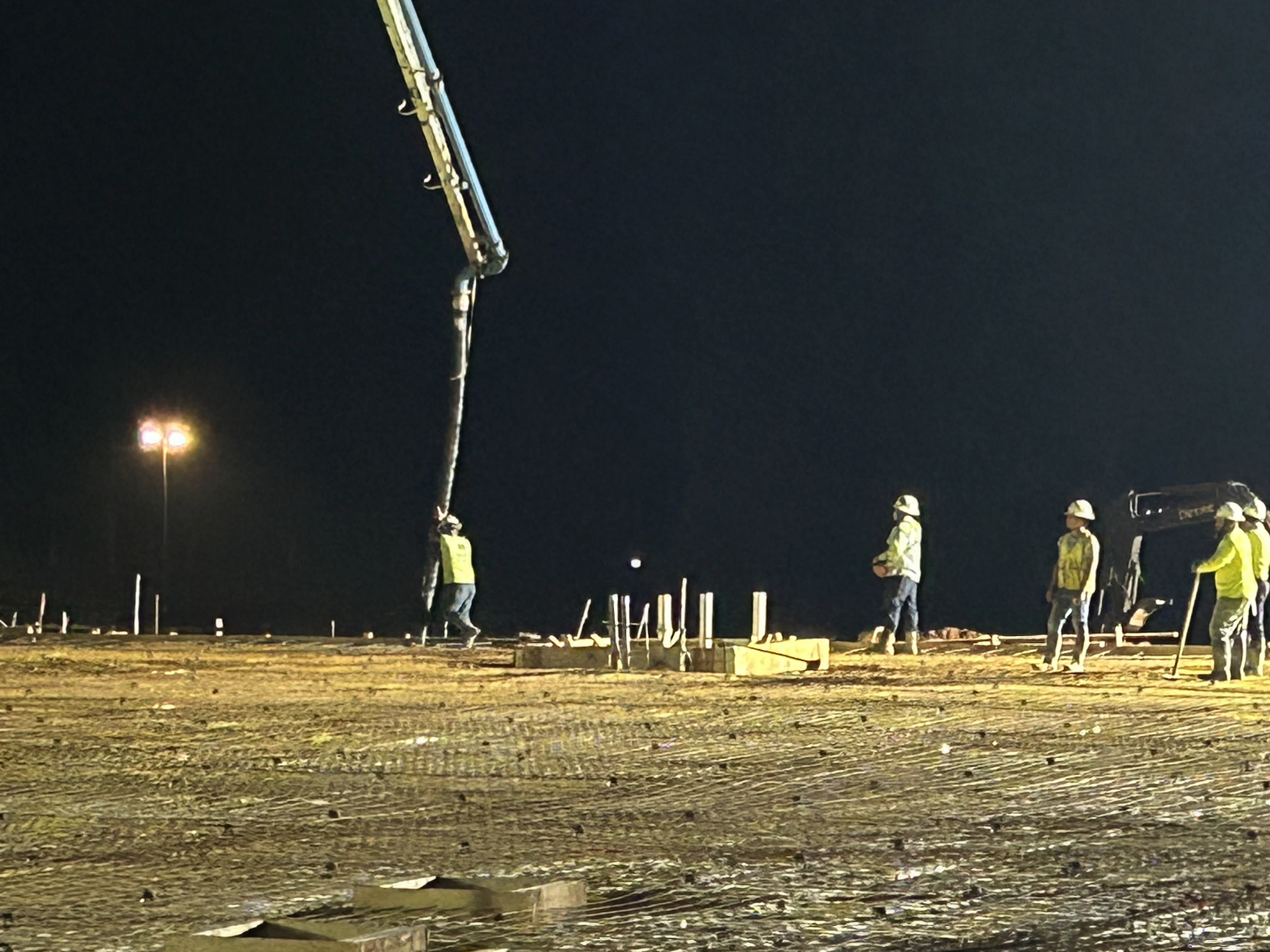

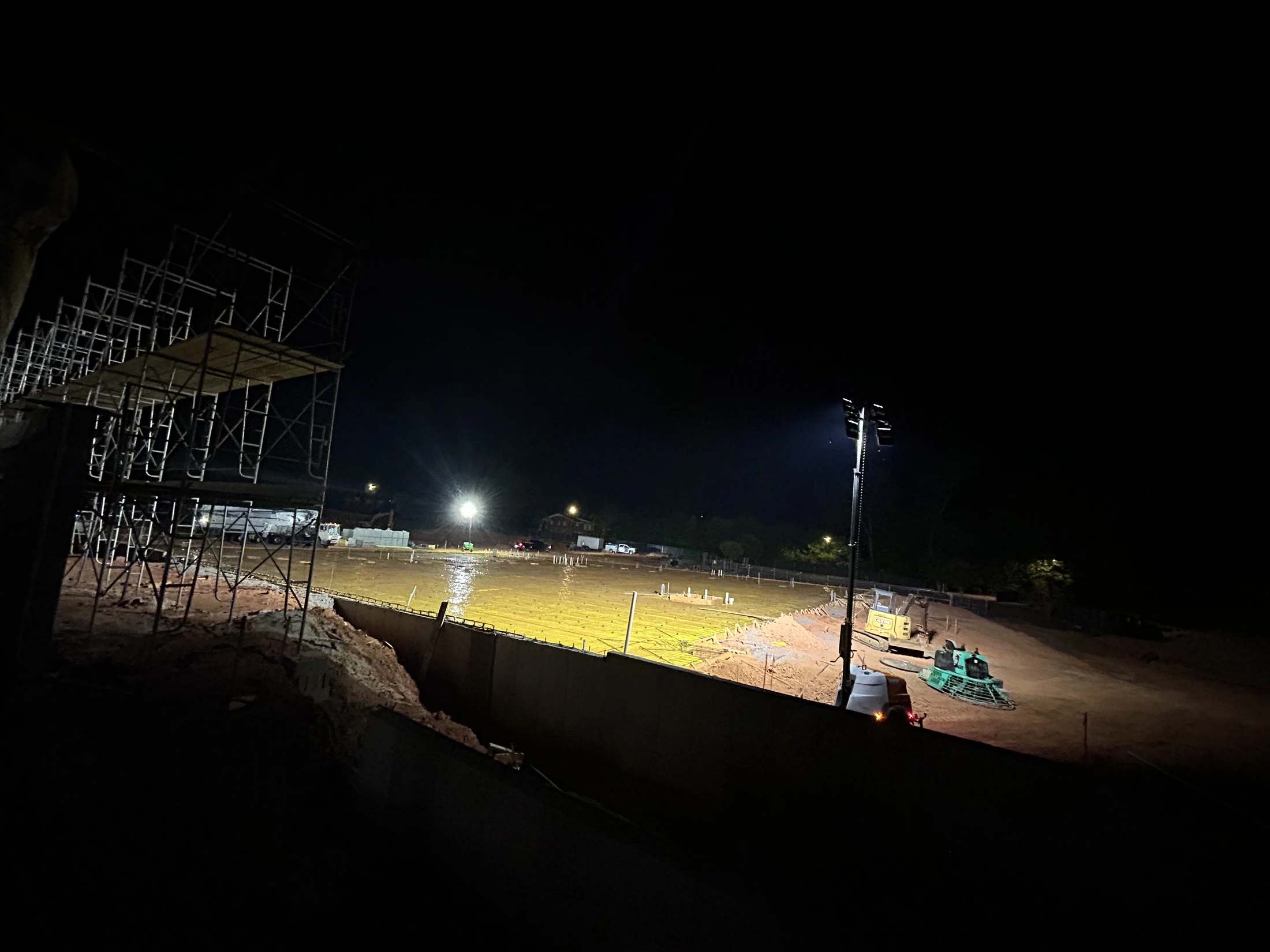

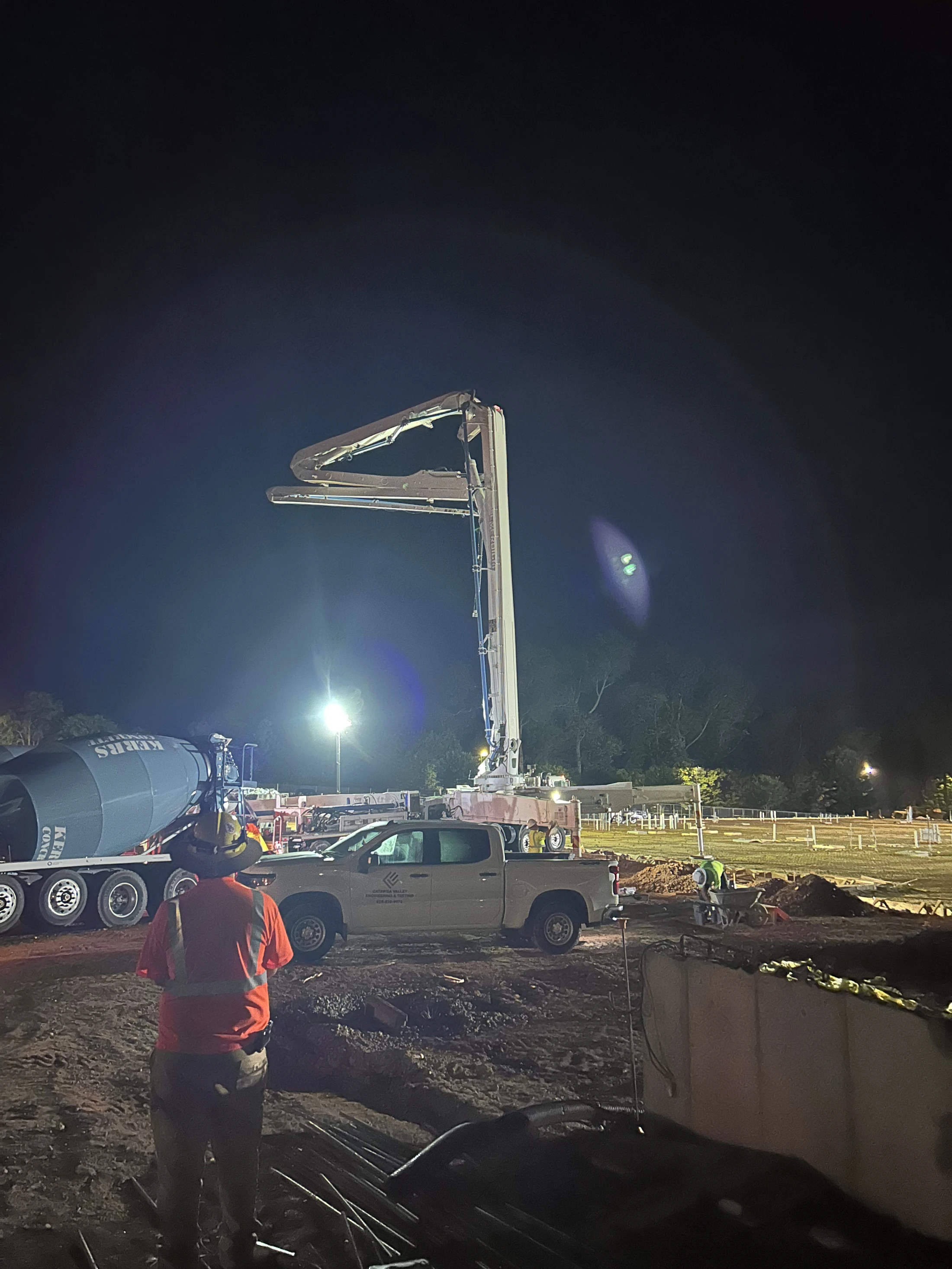

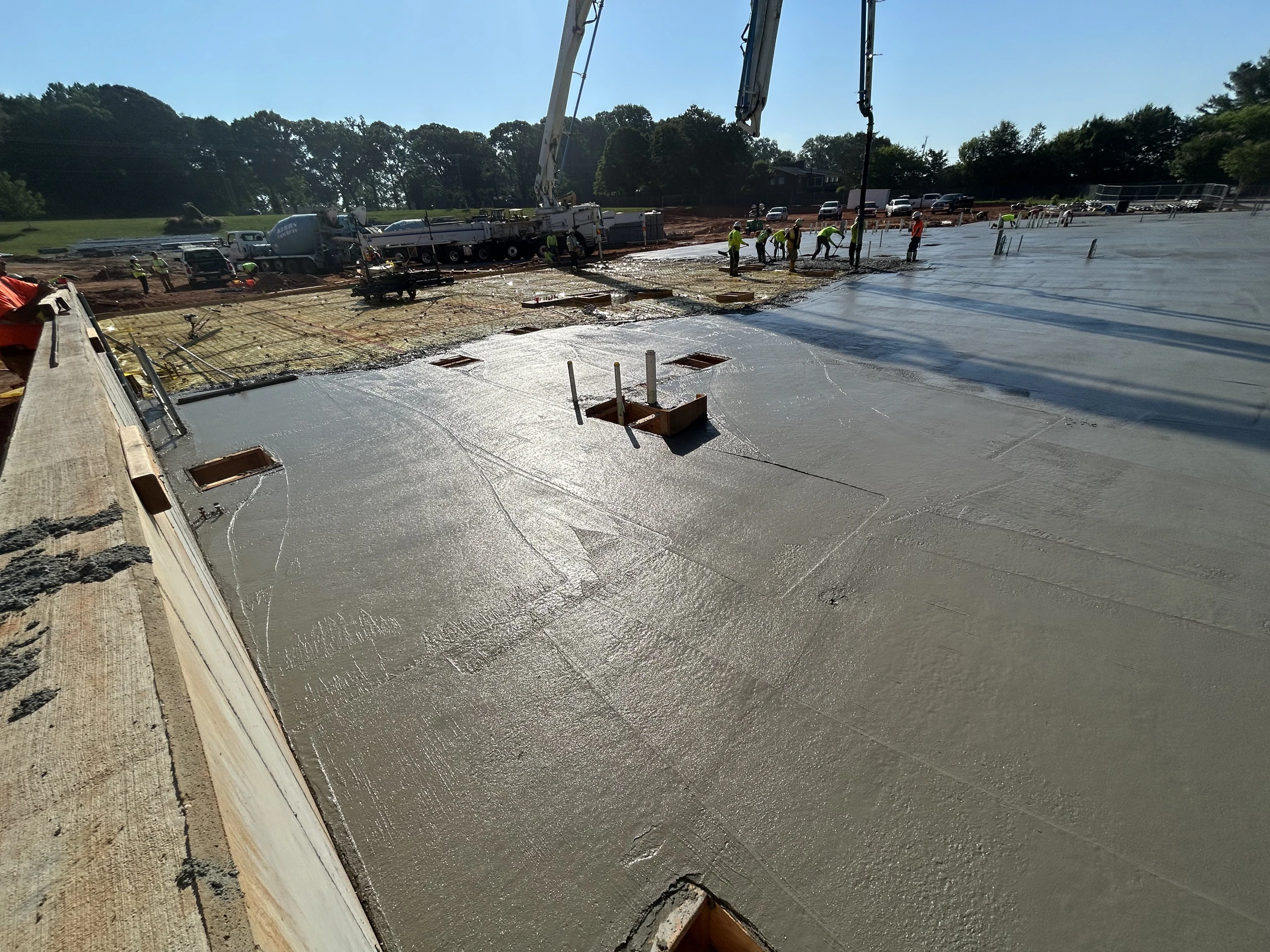

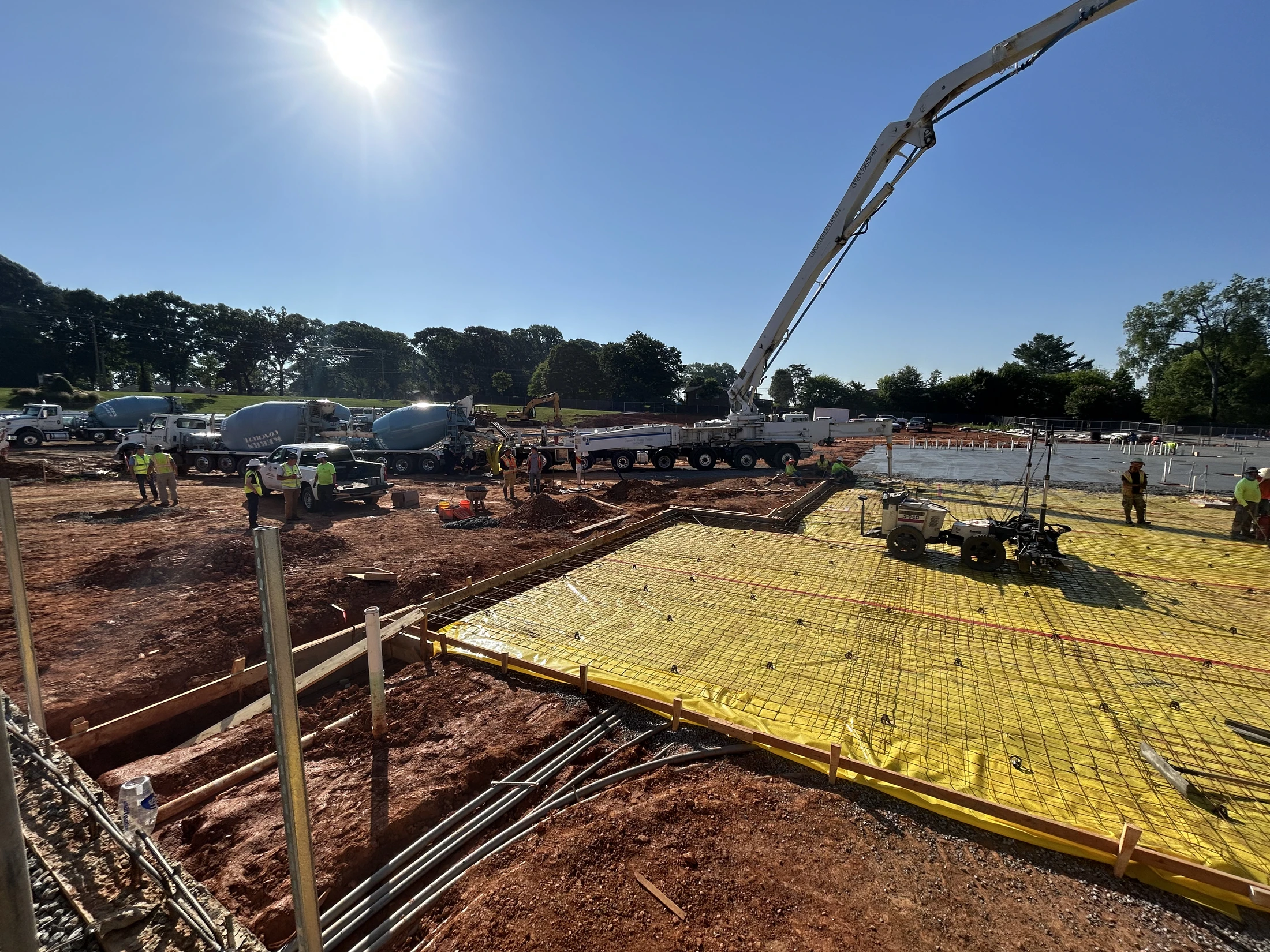

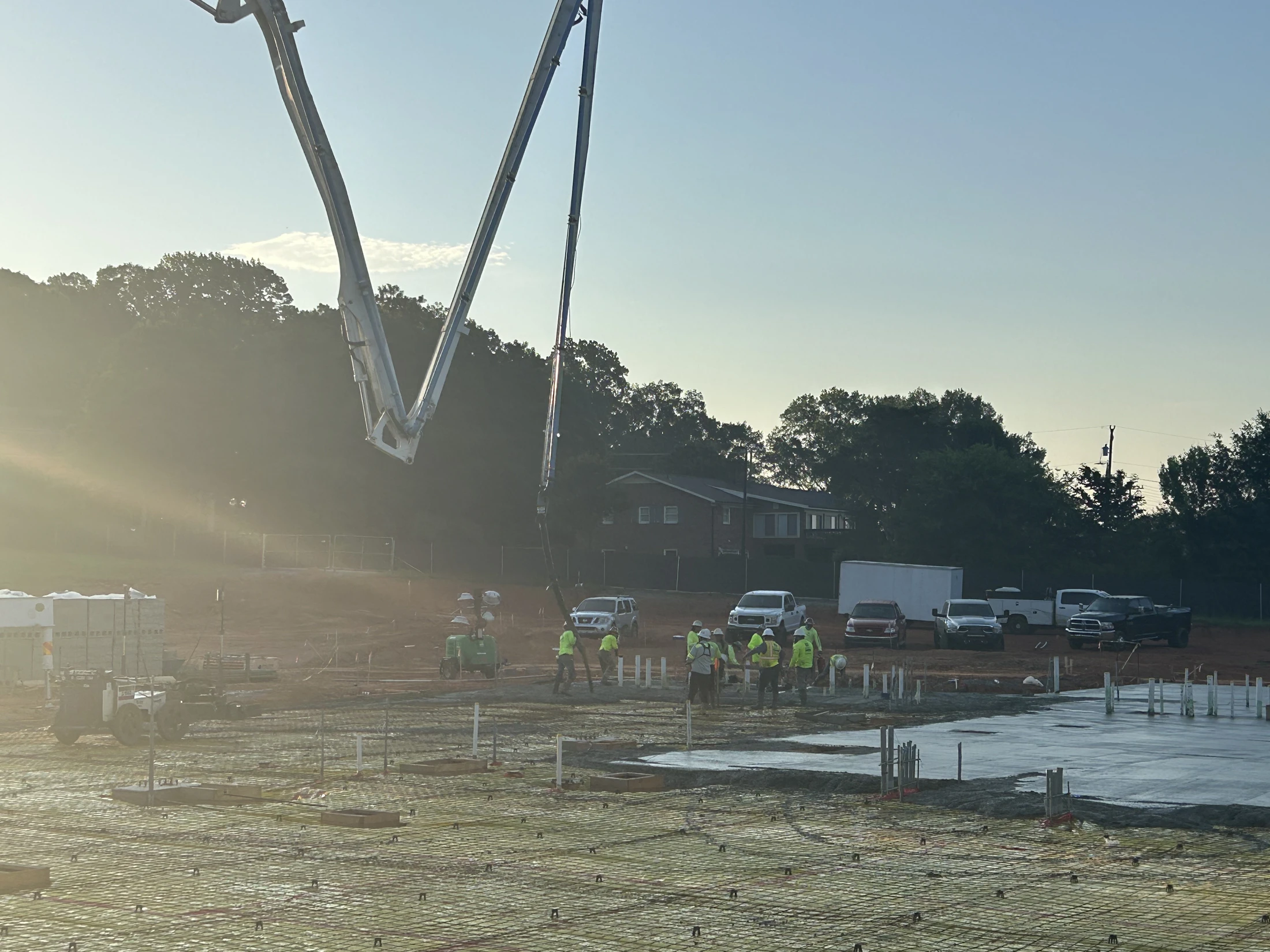

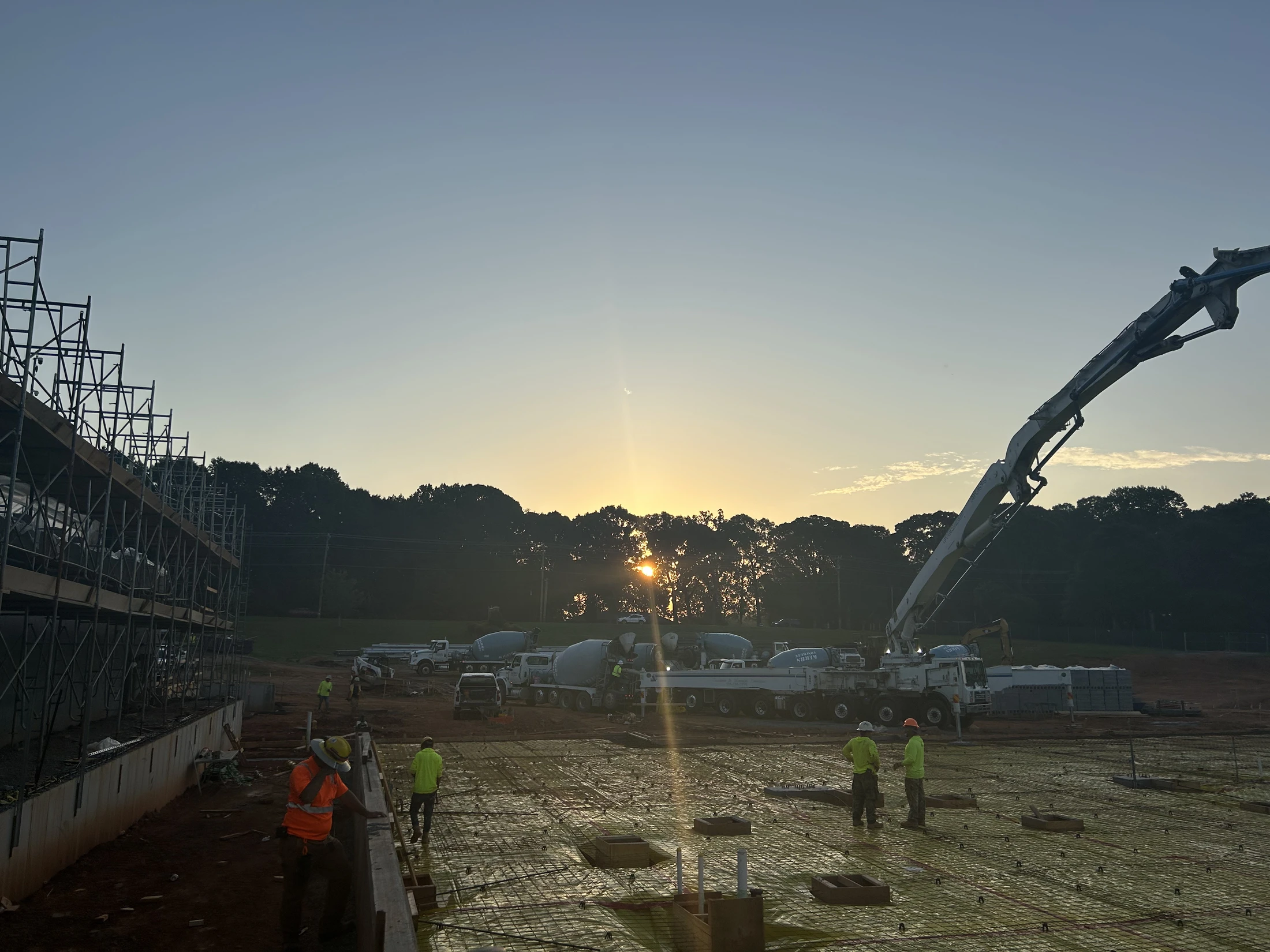

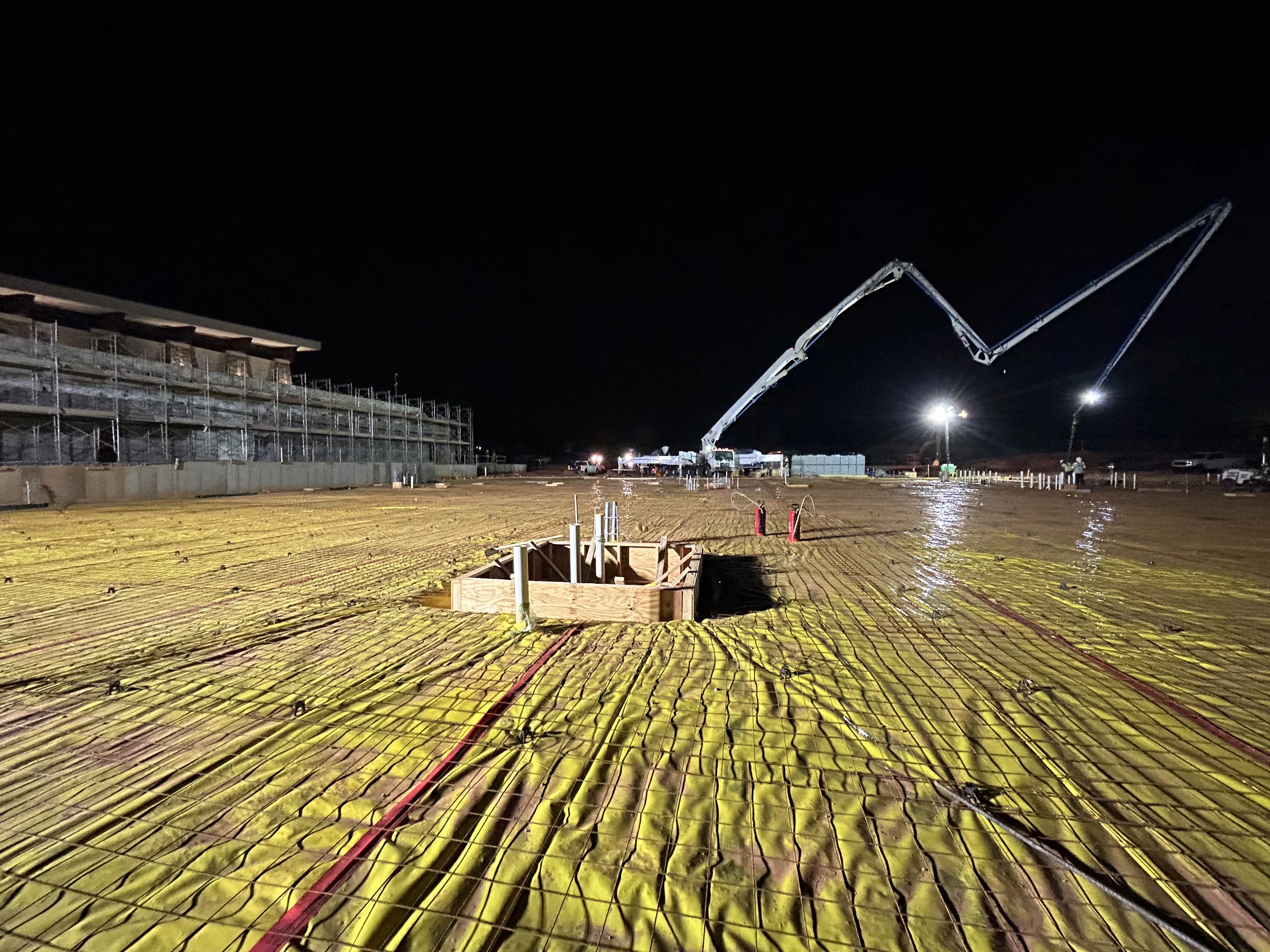

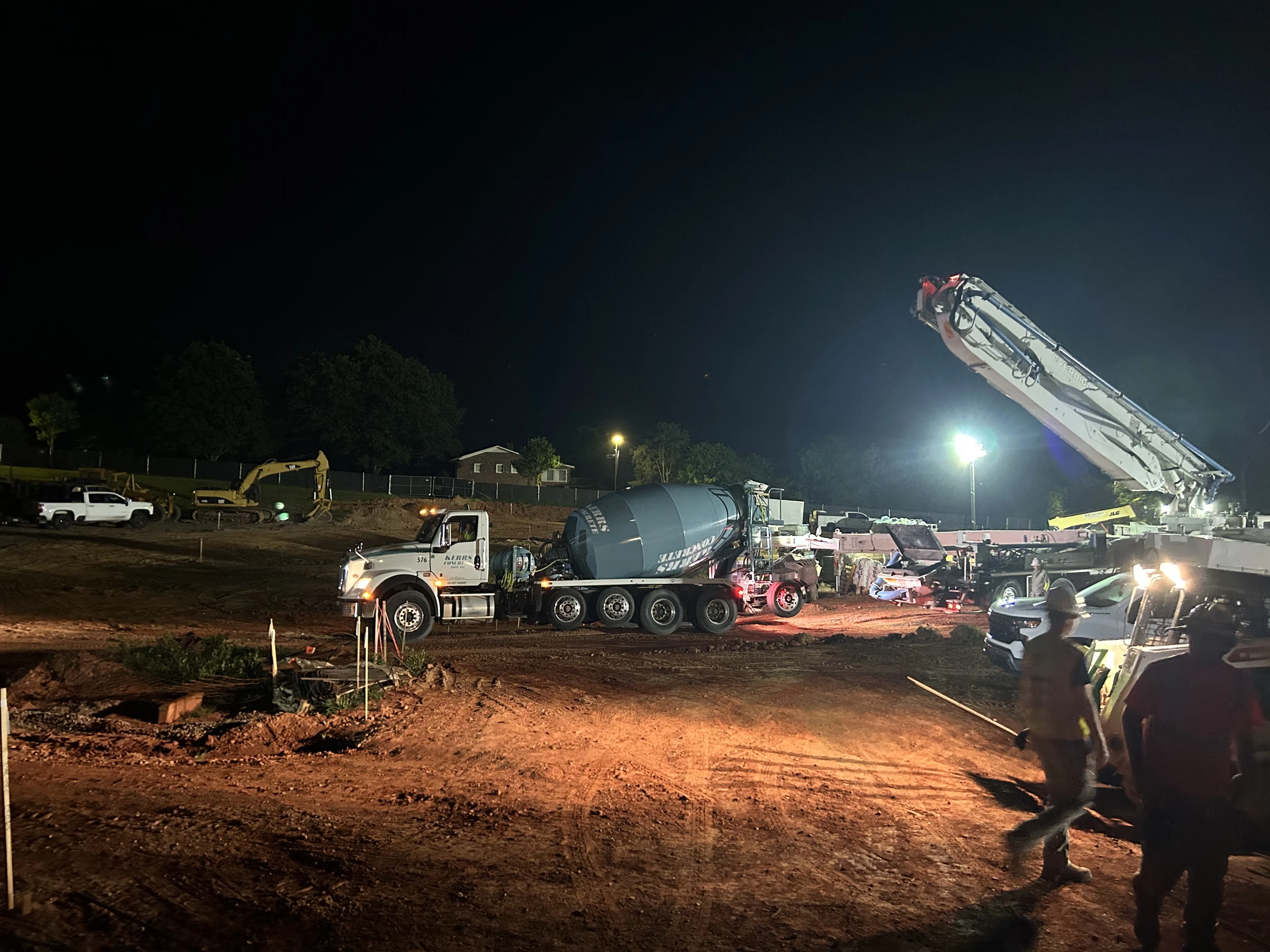

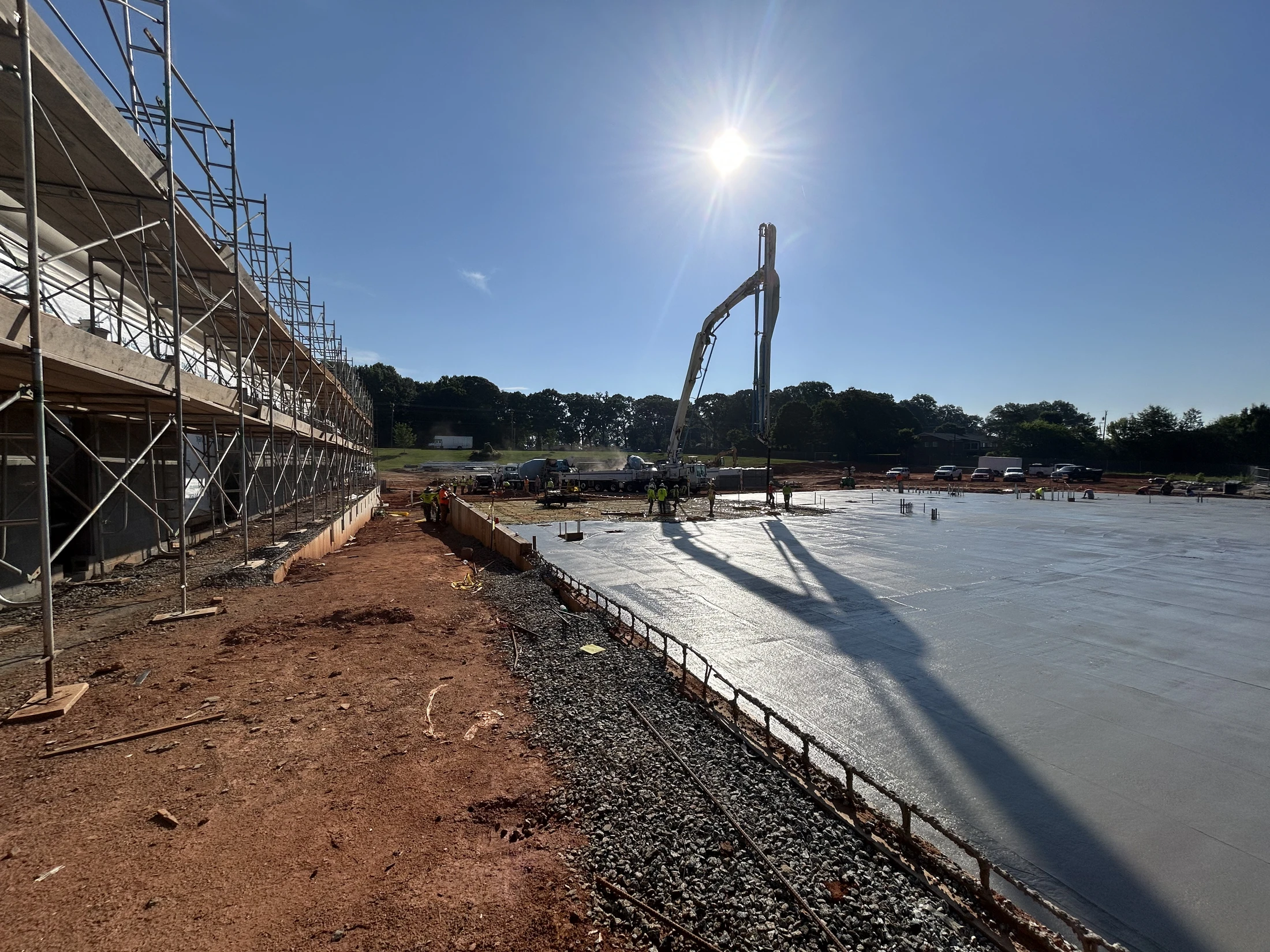

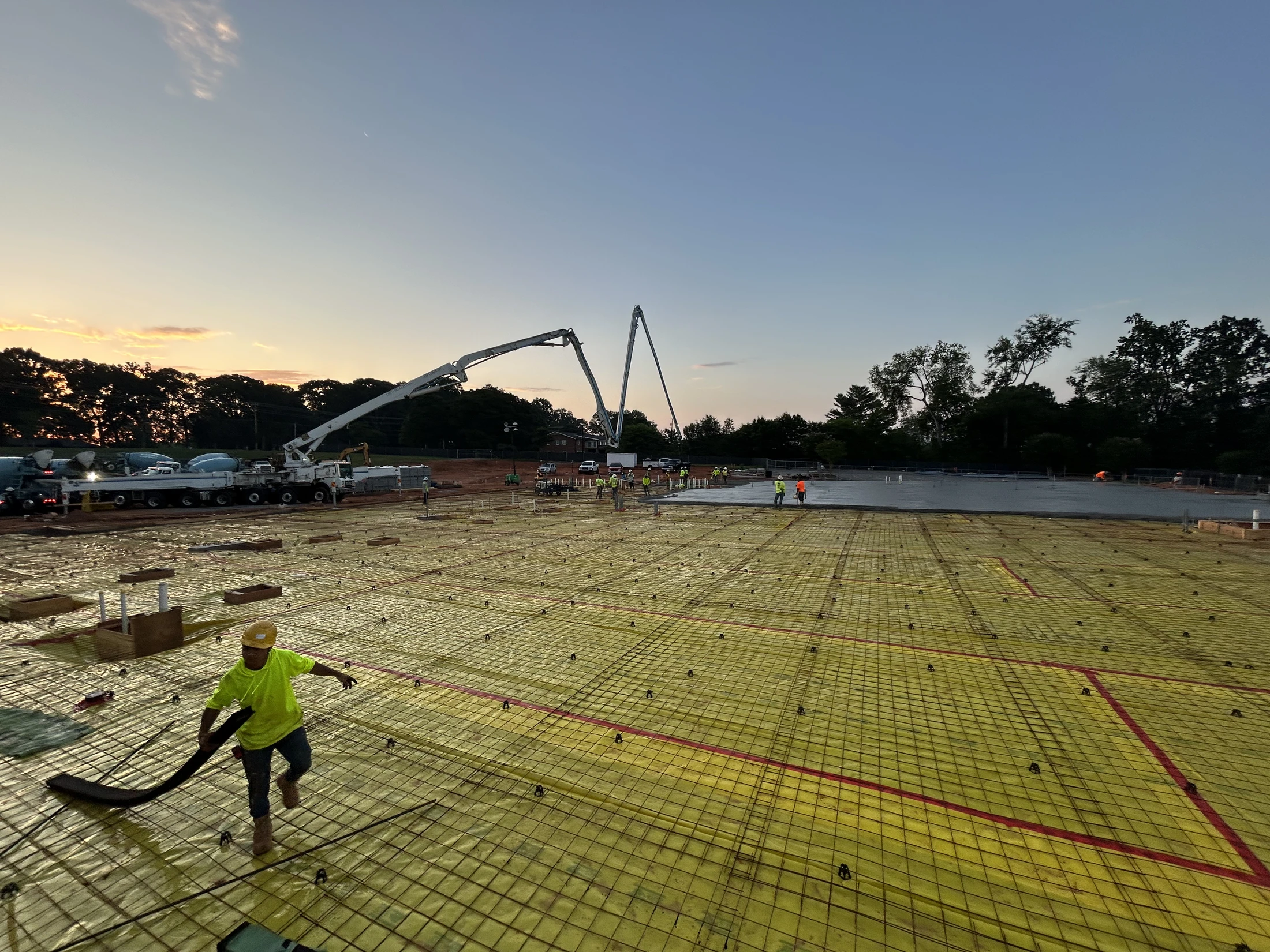

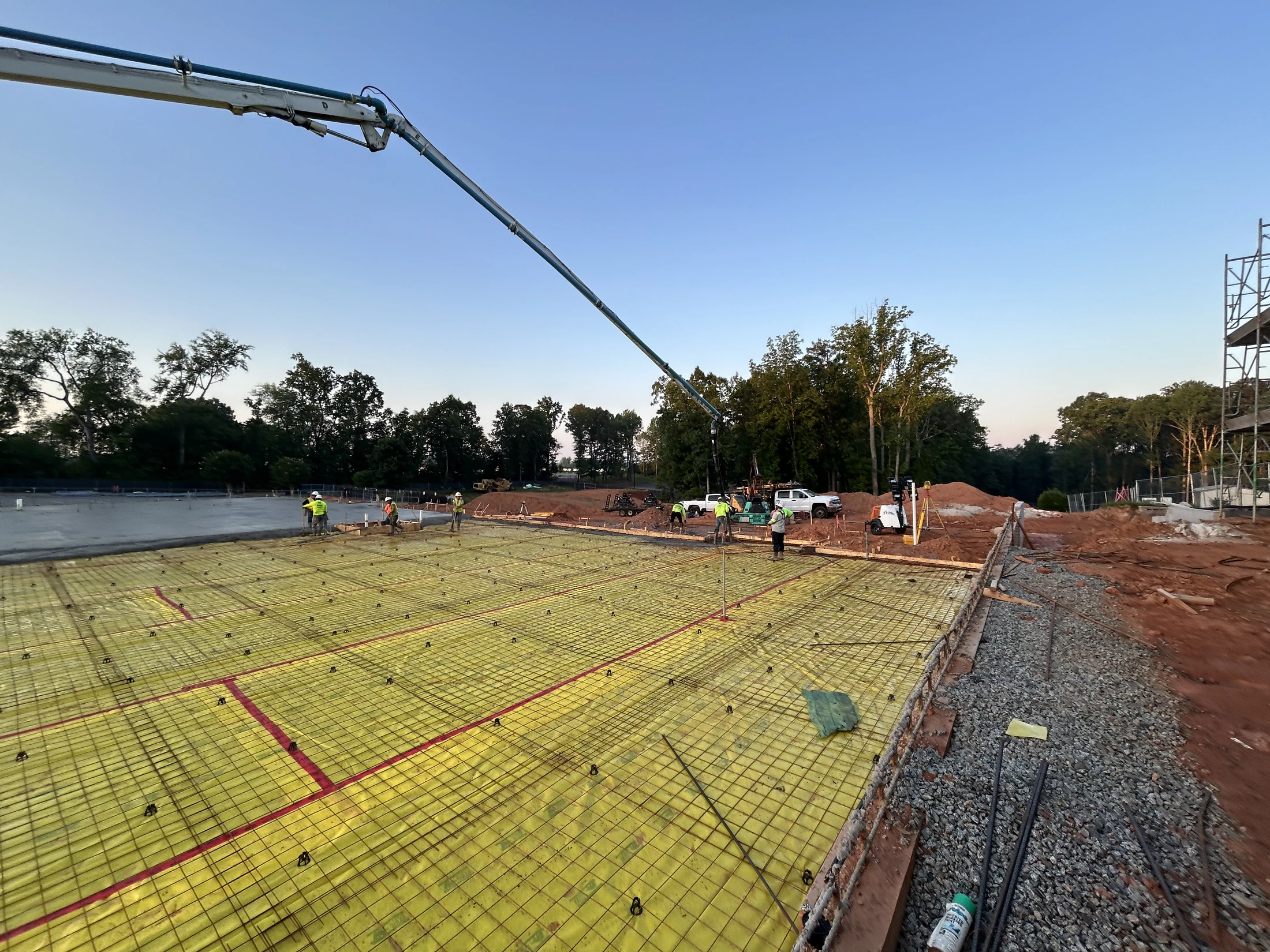

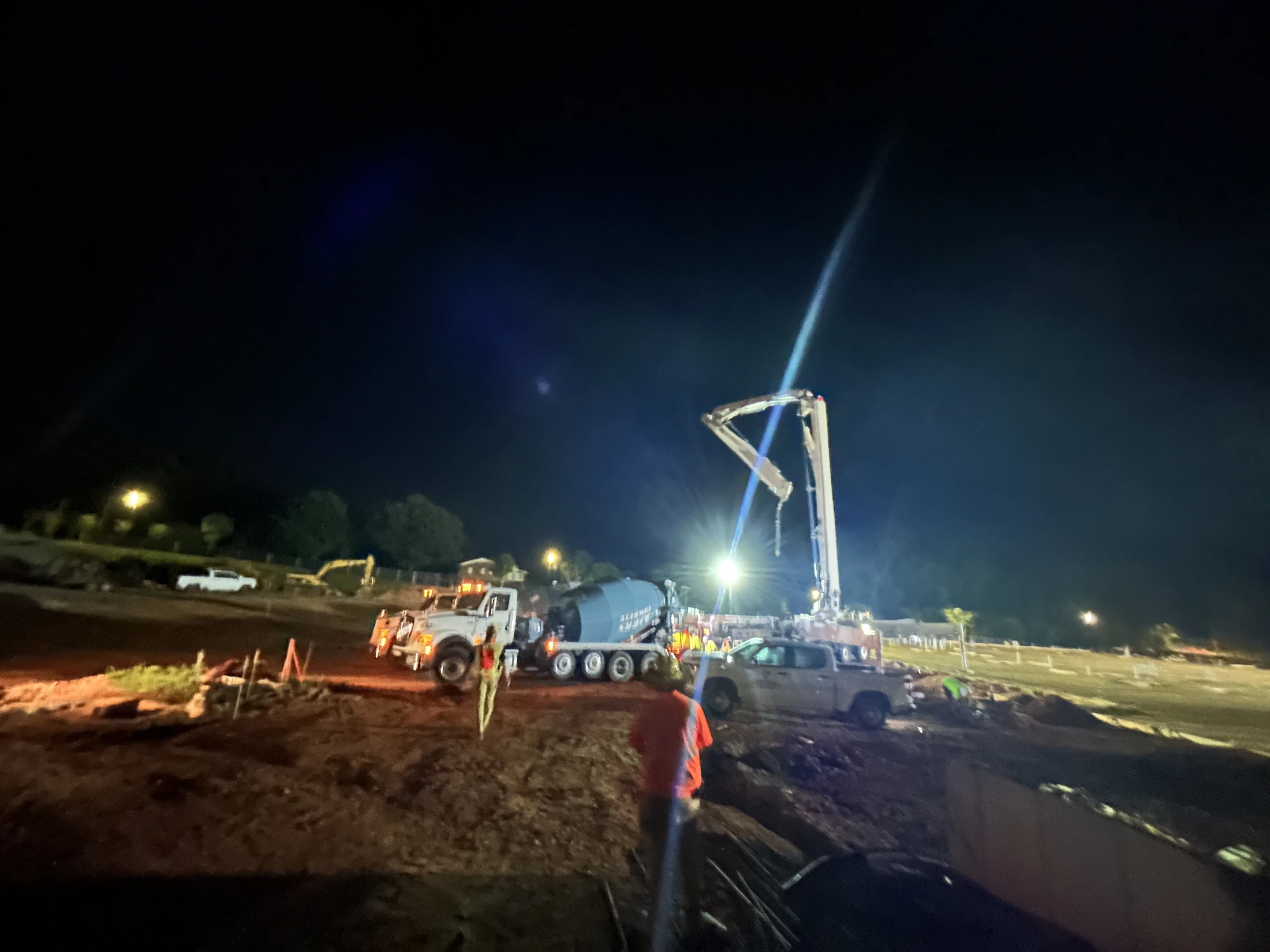

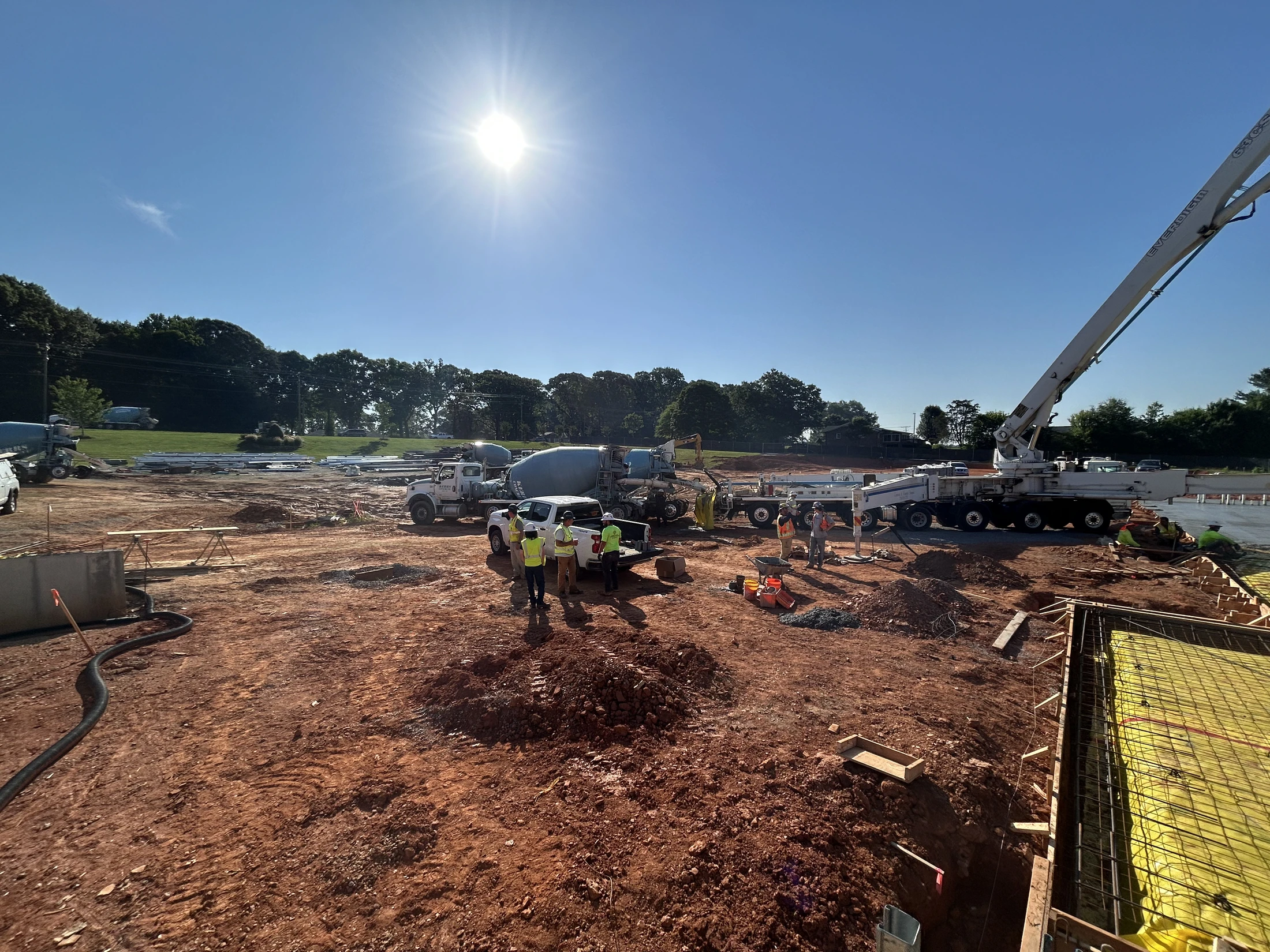

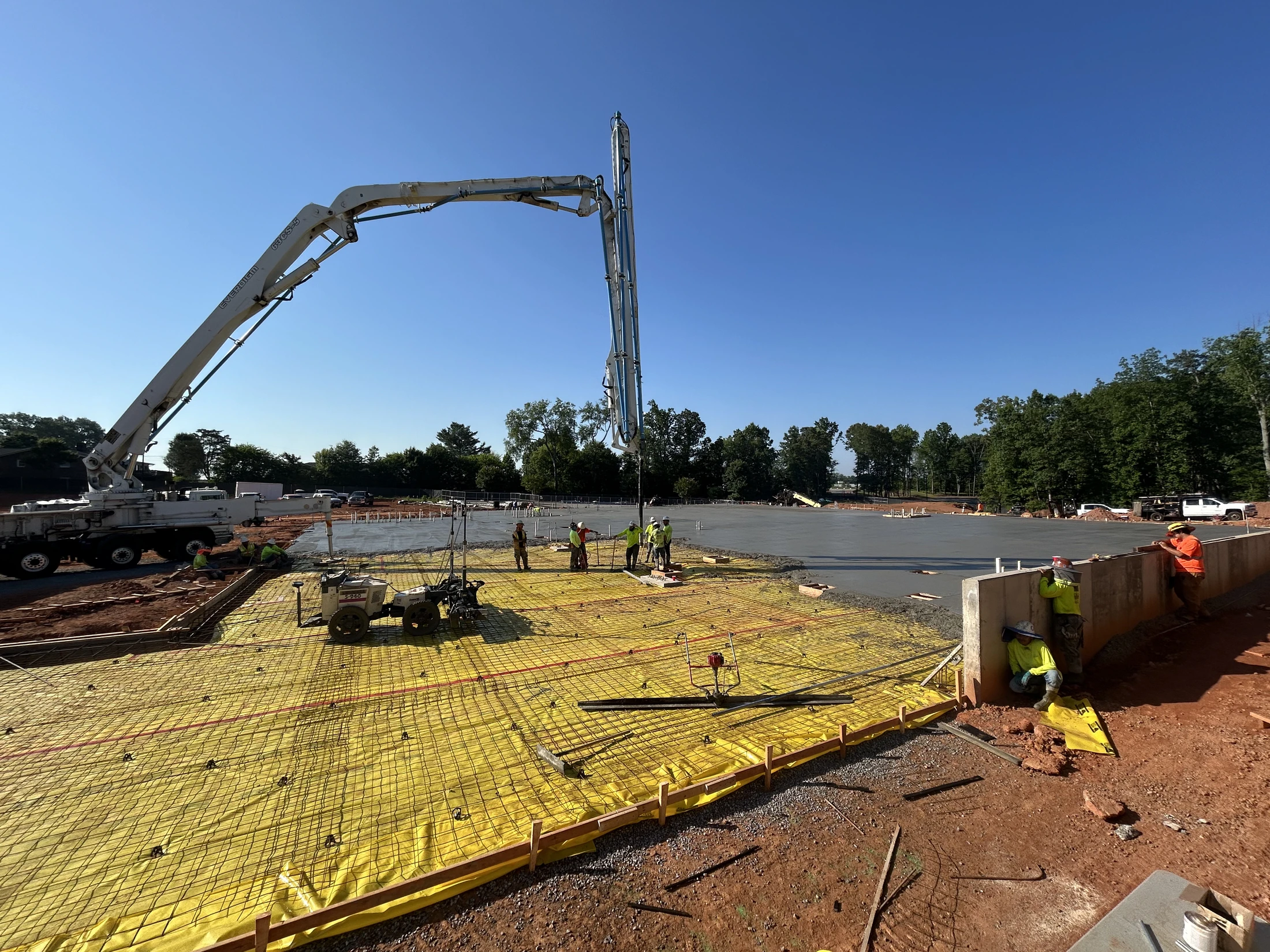

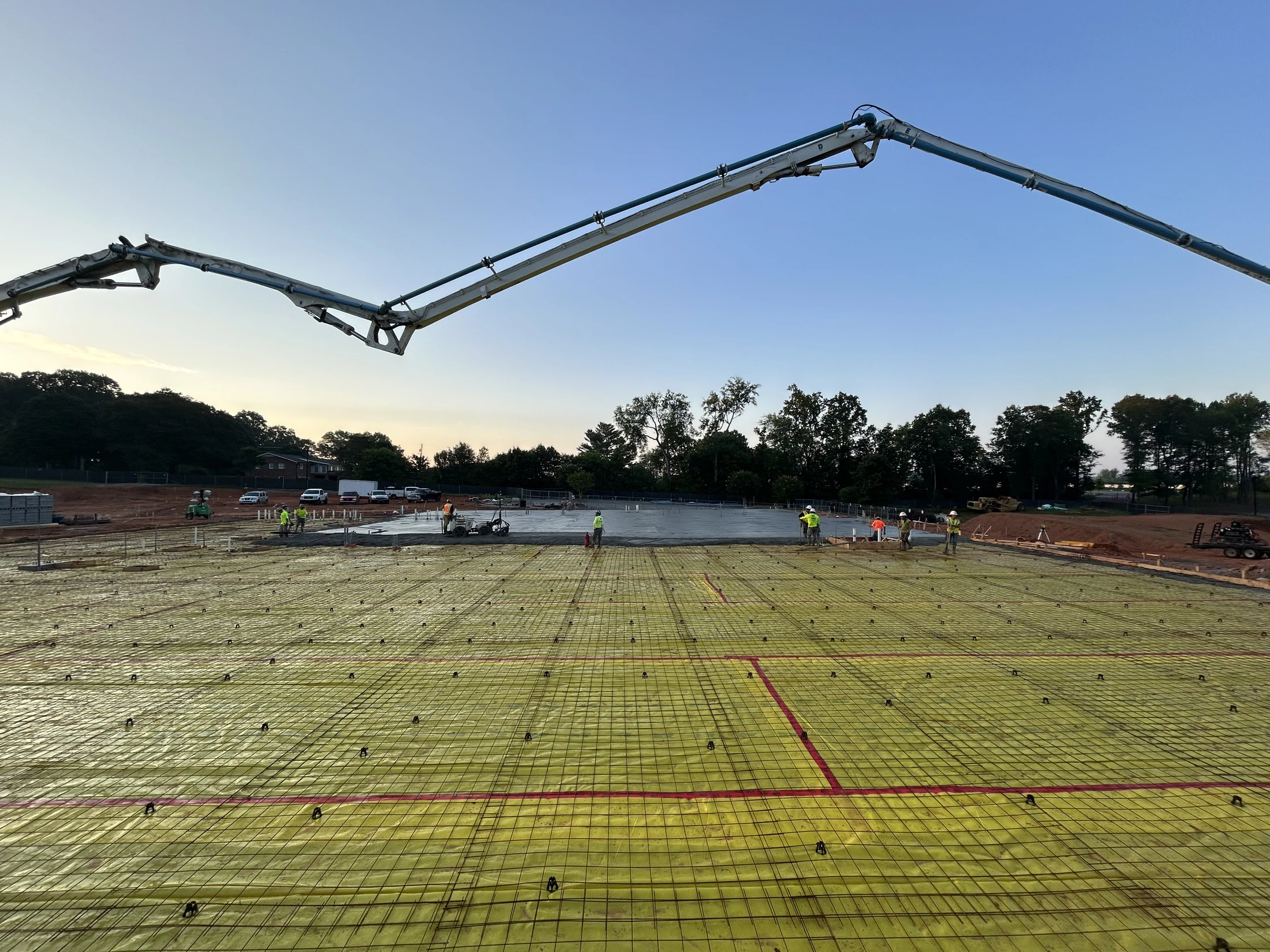

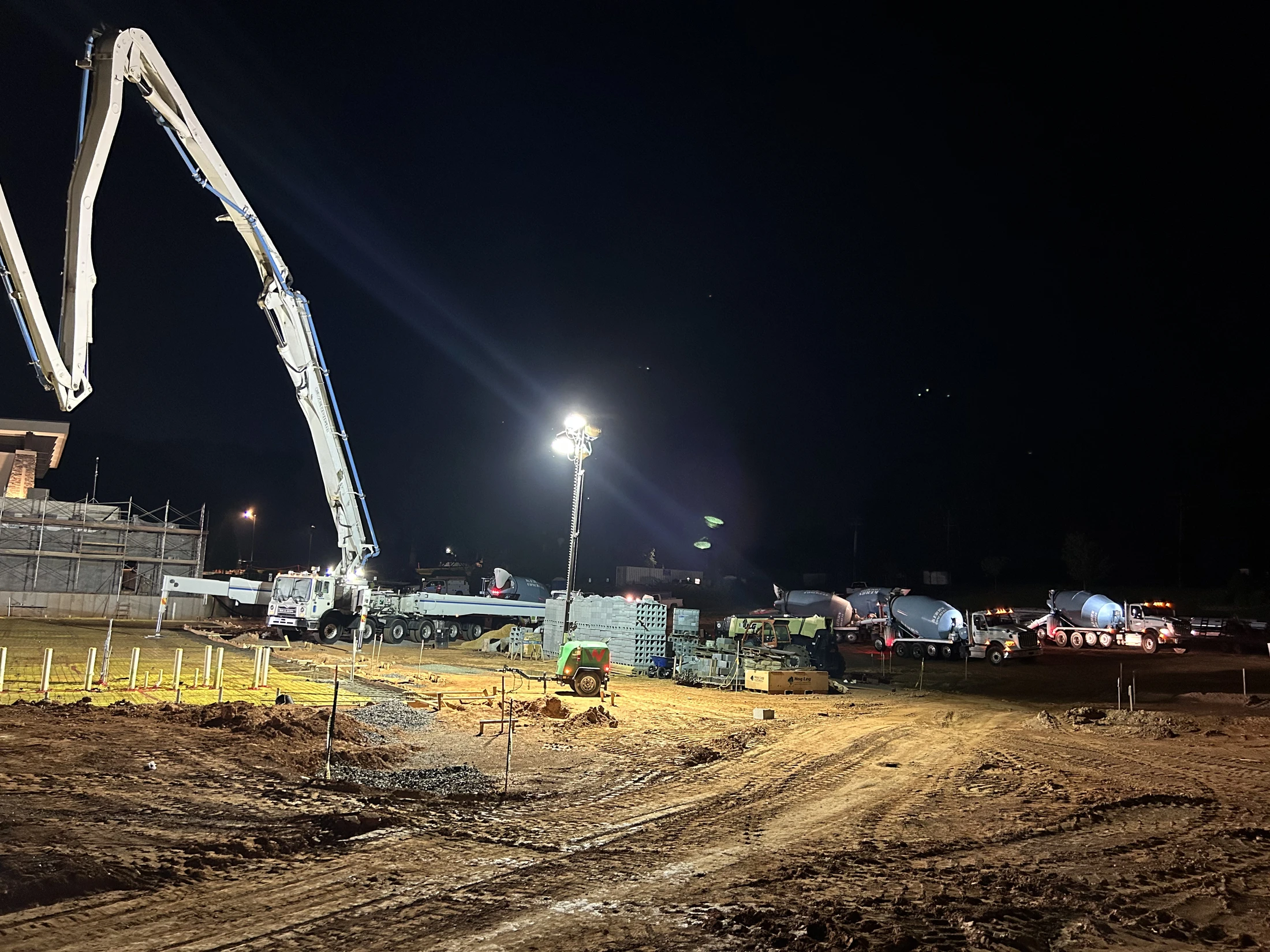

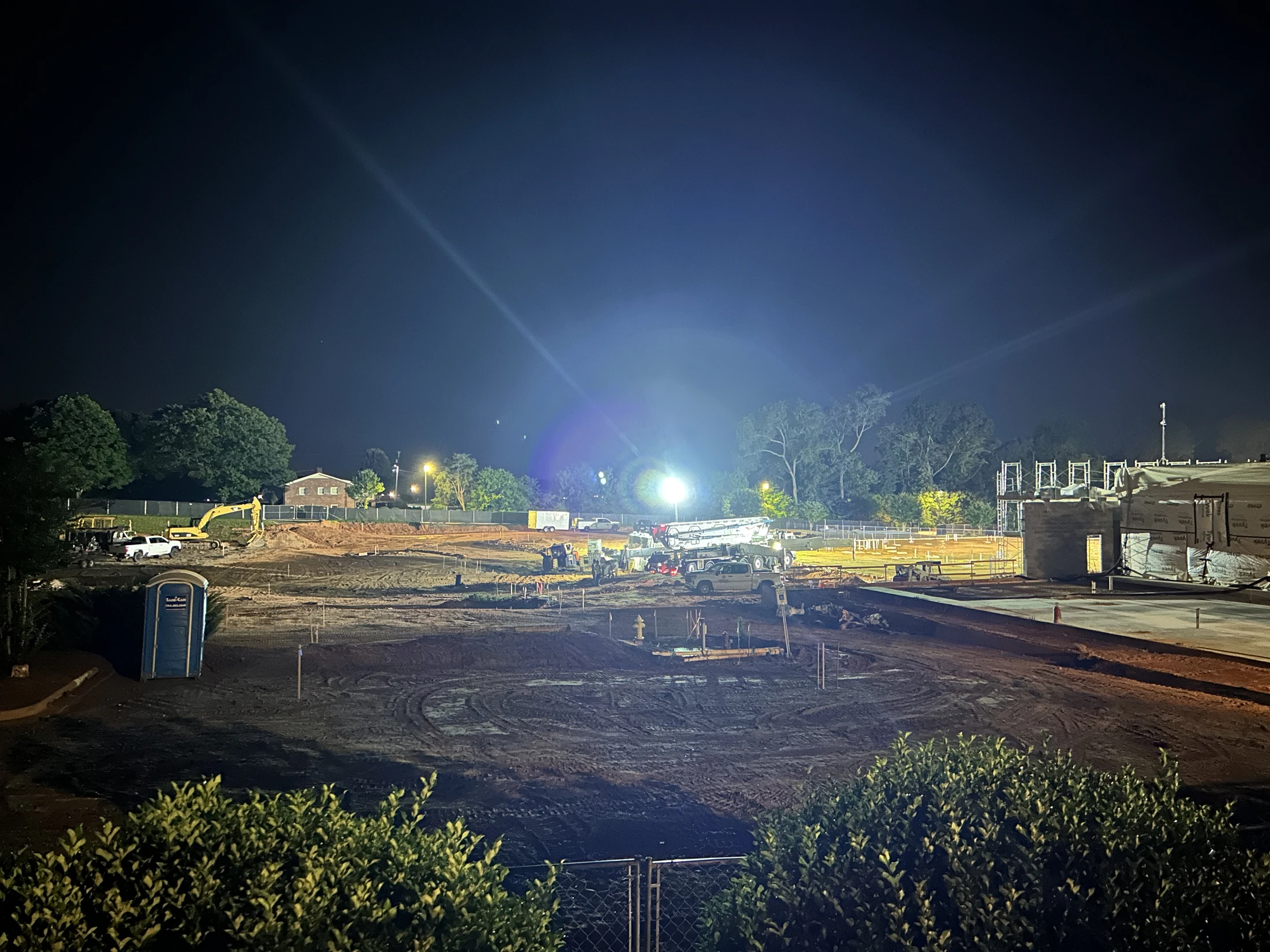

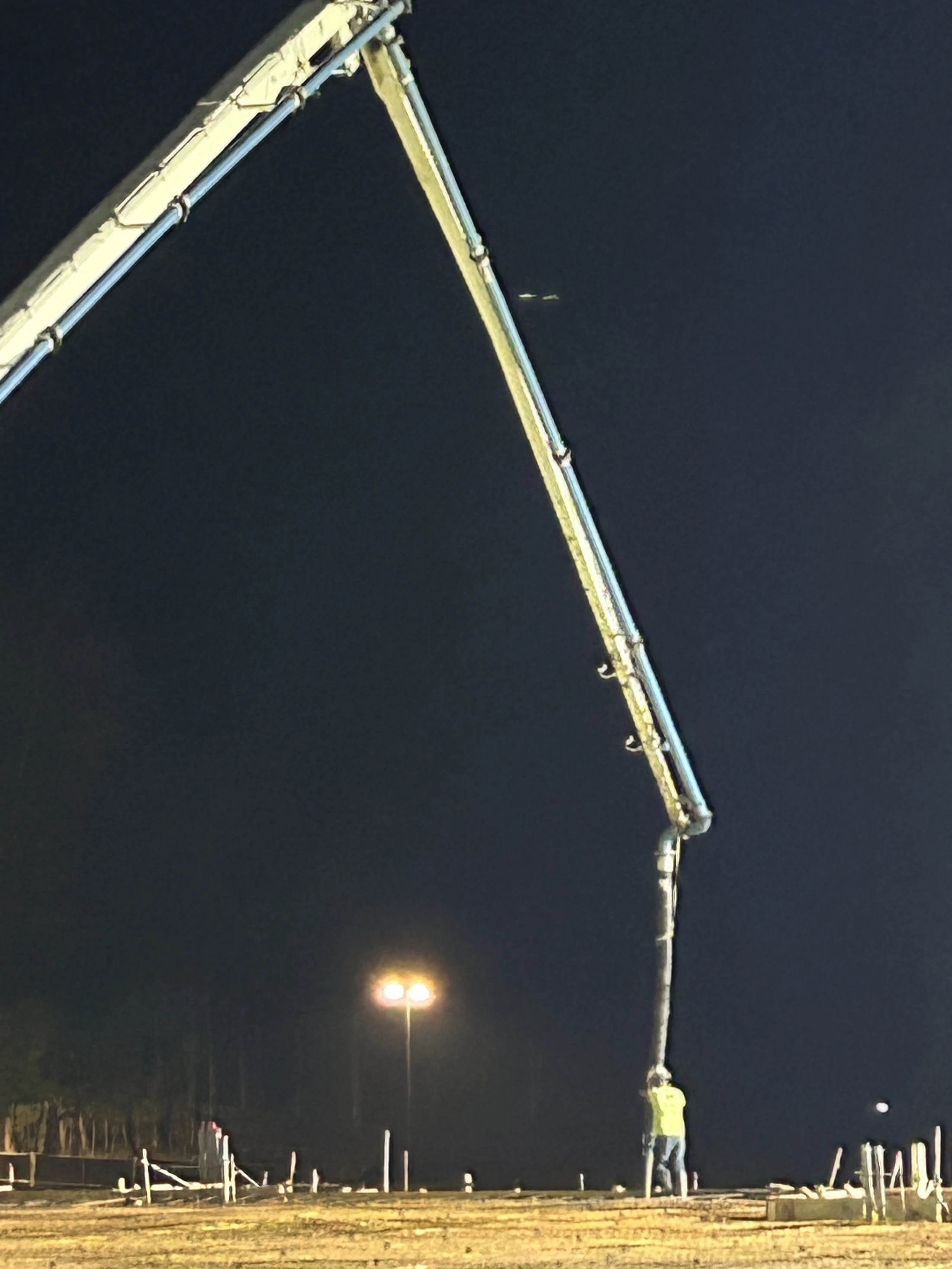

Concrete contractors poured and finished the concrete slab for building “A”. (27 men)

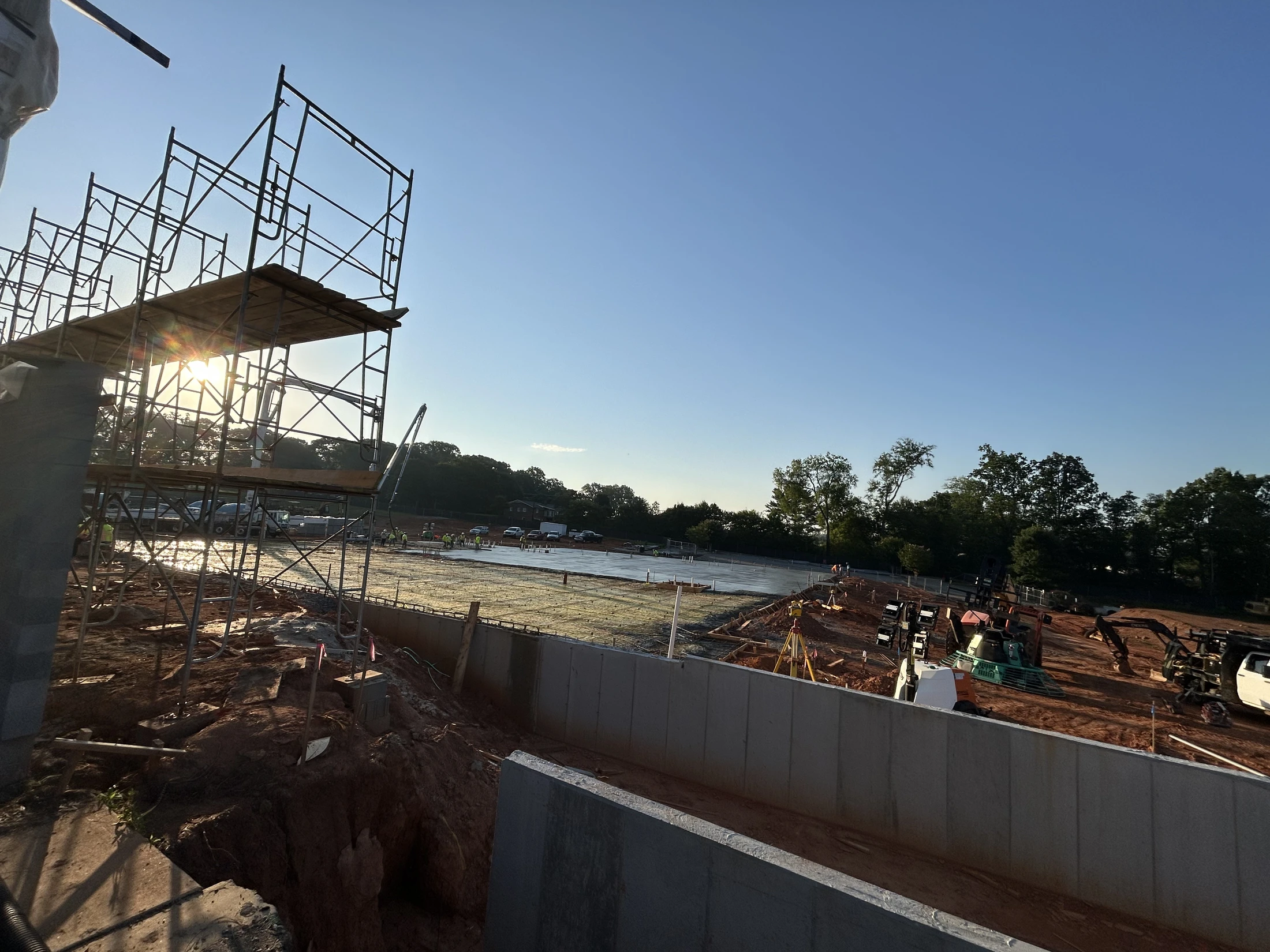

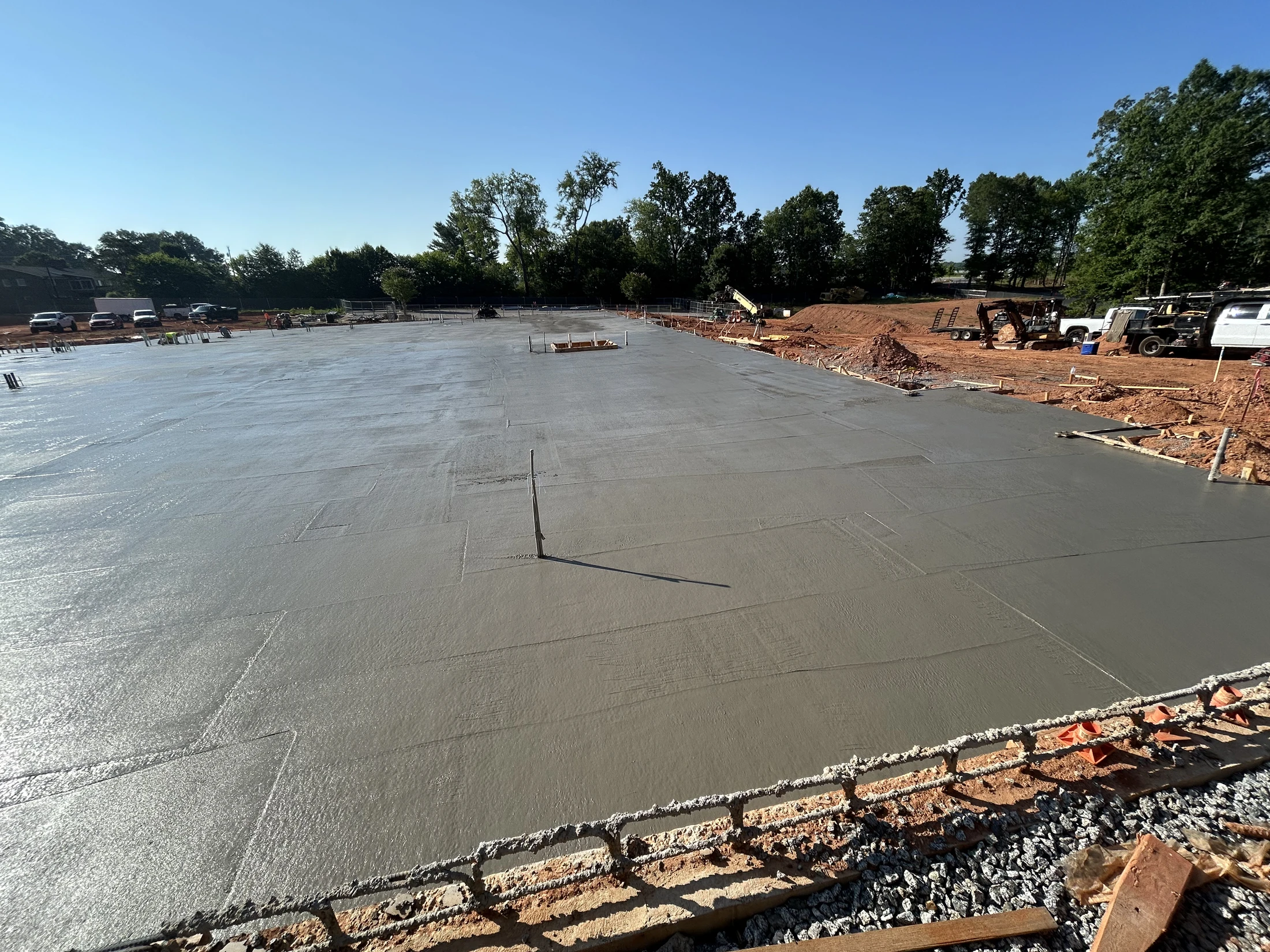

Building "A" - Slab Pour



























Back Entrance & Kid's Area
