Building Project Update for 5/12/2026
Upcoming Activity
Footers are continuing on building A and coming along great. No poor soils were found in an area where there were some concerns so that is a benefit. Footer placement is on schedule for a 6/1 slab pour.

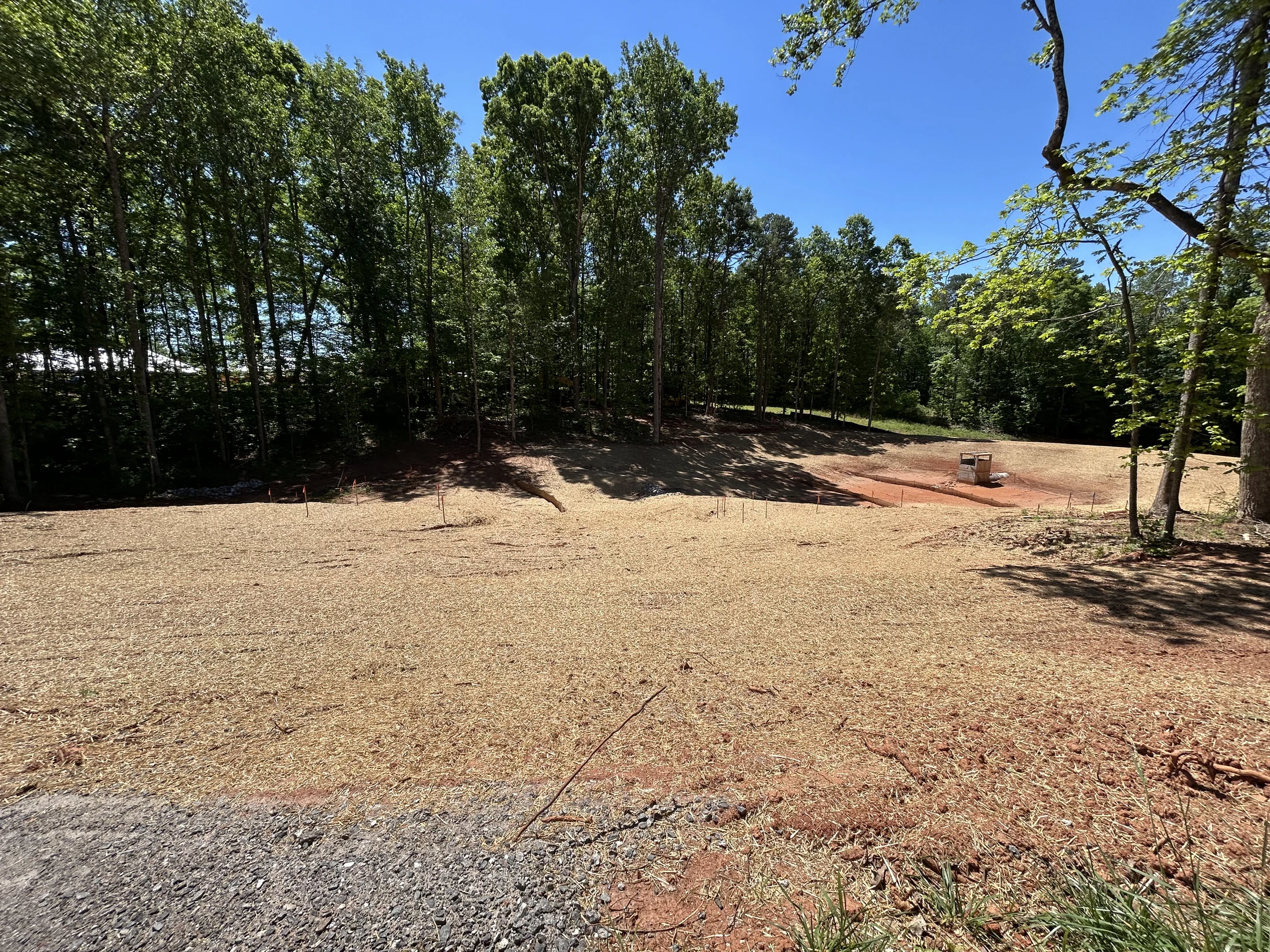

Footers for building B have been started and are making progress.

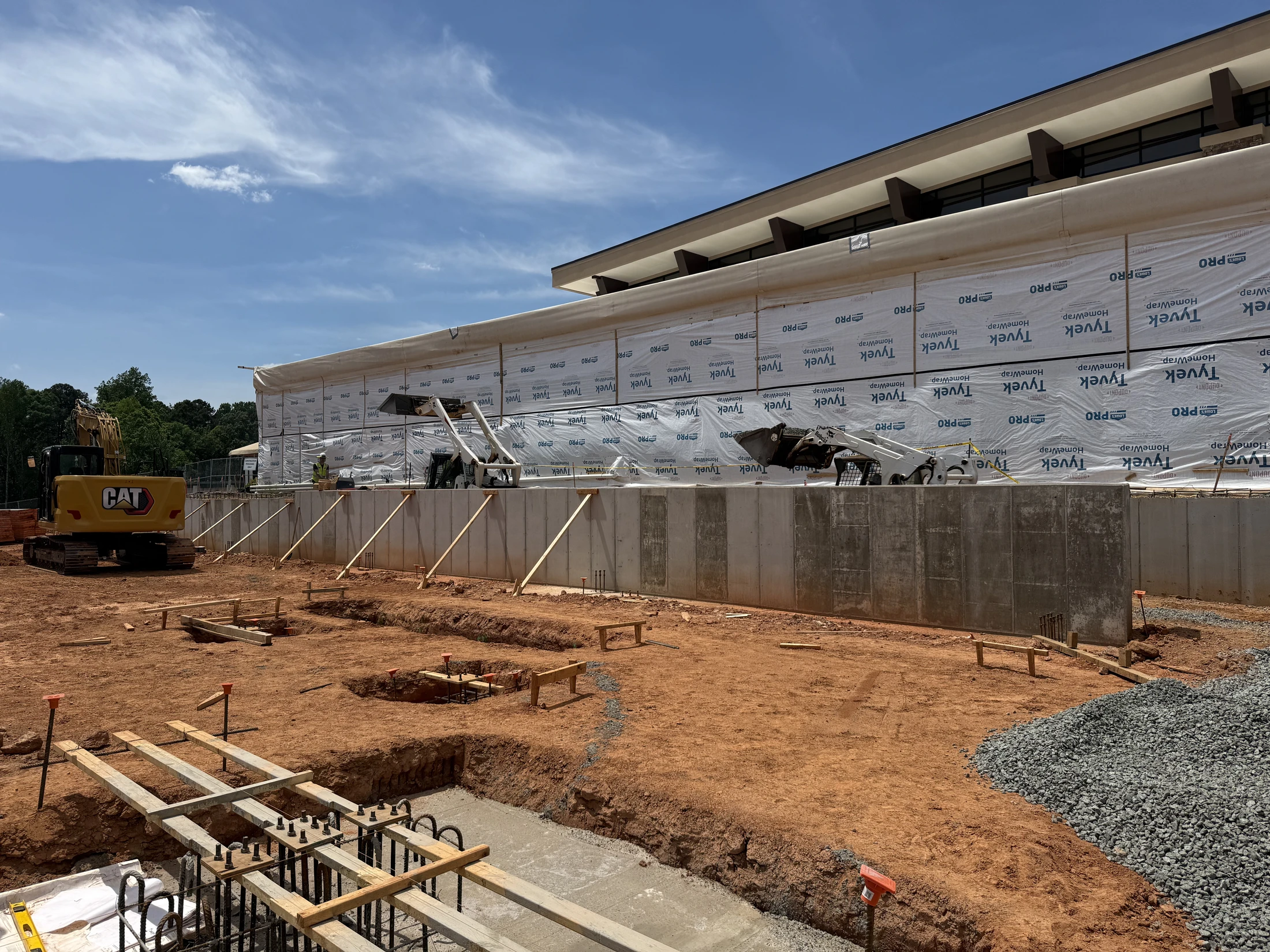

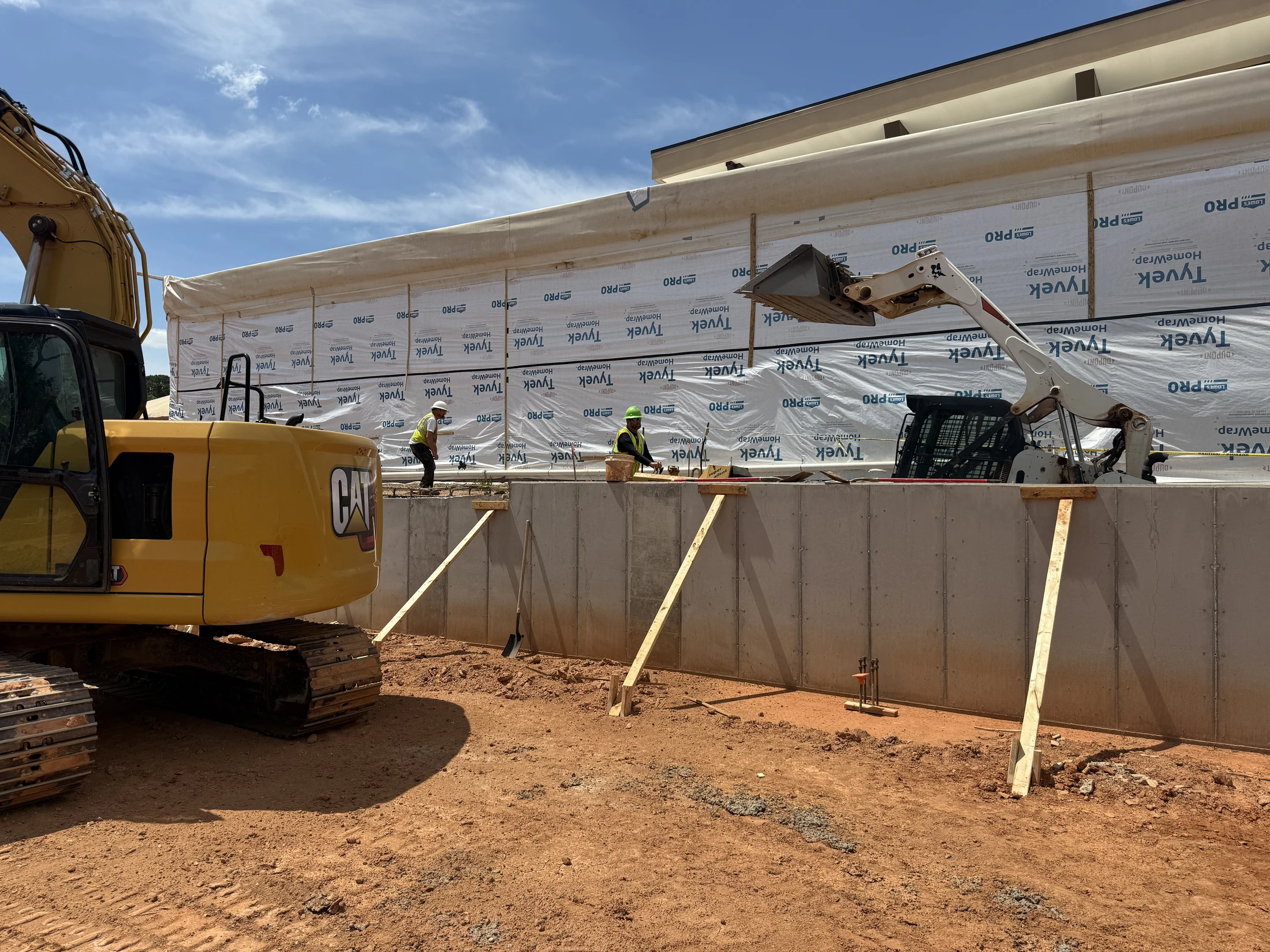

The foundation for the fire wall has been poured and is curing. The brick masons are expected on site Monday (5/18) and moving in their materials with work starting on the wall after they get settled in

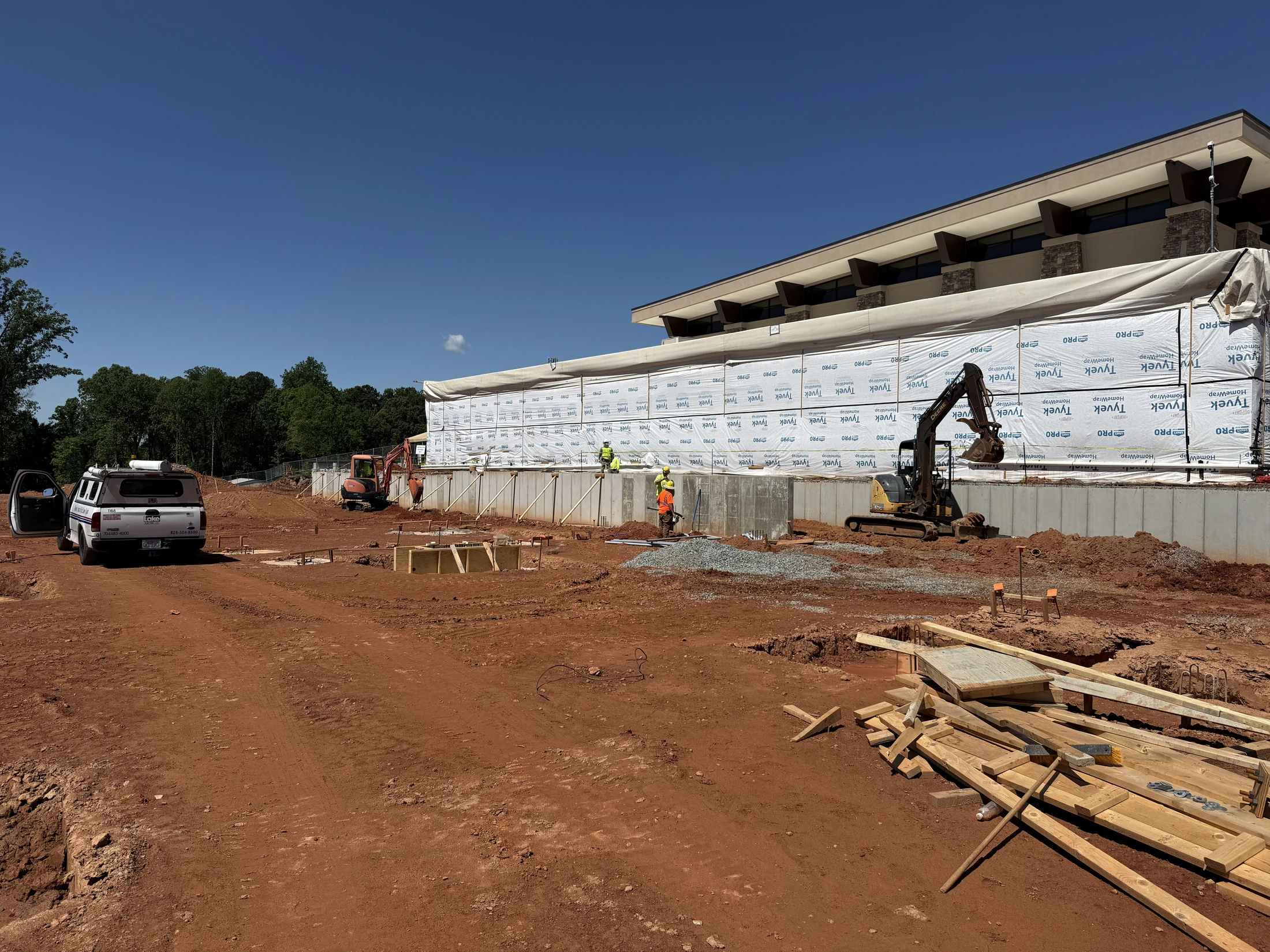

The building A slab is on schedule for a pour date of 6/1 to 6/3 depending on the weather.
Between the fire wall going vertical and the huge building A slab going horizontal...the project site is going to start taking shape quickly throughout June. It will start looking like a building very quickly.
The plumbers are nearing completion on their work for under the slab. They have a bit more work and then inspections. After inspections they will backfill their trenches in preparation for the slab pour.
The electricians completed the installation of the AVL (Audio, Video, & Lights) conduits that are going under the slab. Our AVL contractor inspected the work yesterday and was pleased with the work.
The electricians are continuing with their electrical under slab work. They are also on schedule for the 6/1 slab pour.

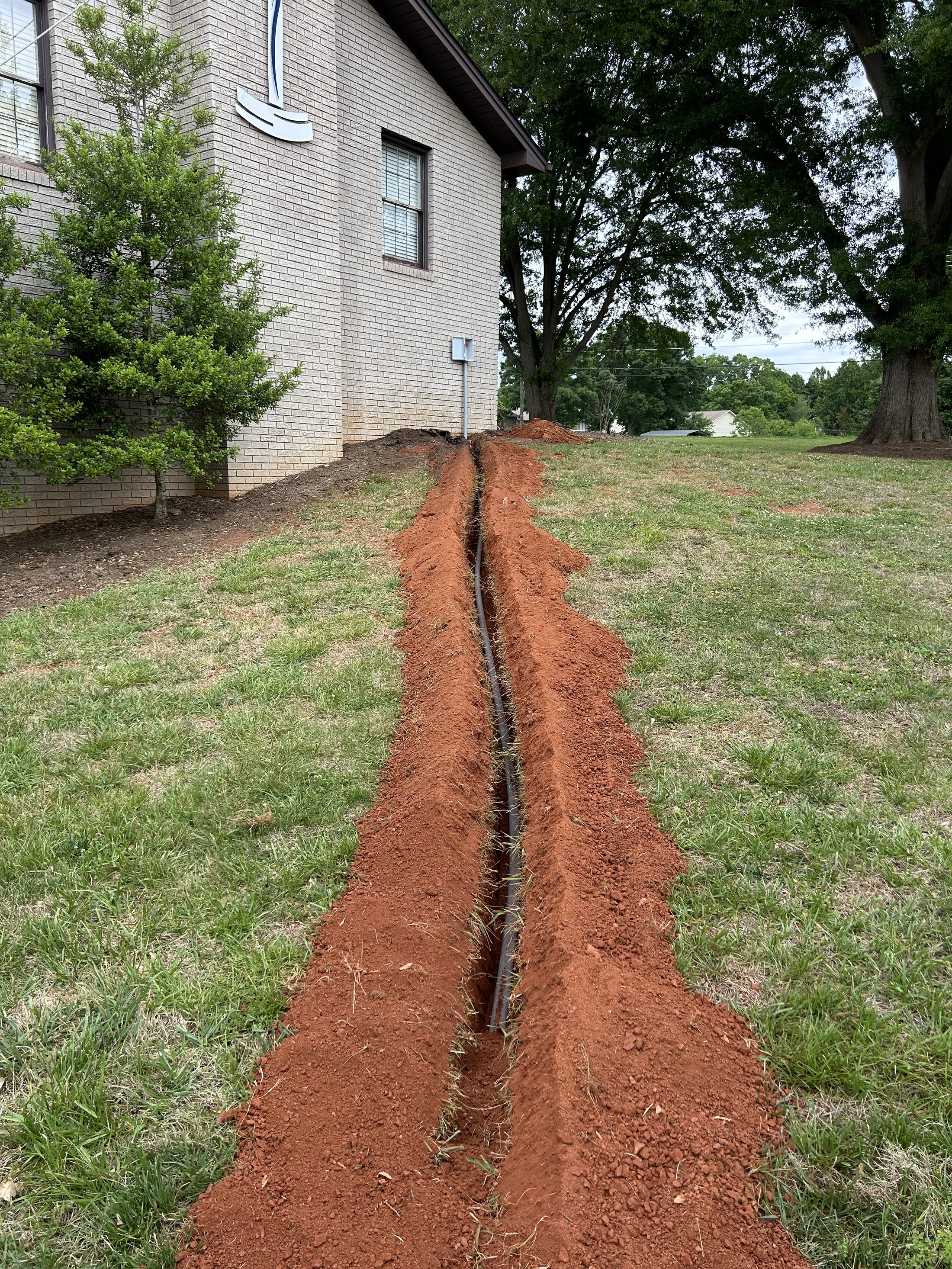

The trench to the Roseman House was created and conduit was placed and covered. The optical cable was pulled in and now the house is online. This means that all buildings on the campus that have ministry taking place in them have a hardline connection that will allow for full access to technology resources and capacity to expand into the future as needed.
I am now working on updating the Discipleship Building. If you have a PIN number to access the Discipleship Building I will be creating an electronic access badge for you. If your PIN currently works on the main building it will continue even after we move to badge access on the Discipleship Building. Once I have the badges ready to distribute we will swap out the current PIN pad for the new style card reader that we will be using throughout the campus and the building project moves forward.
Last Week's Activity
5/04/2026 through 5/08/2026

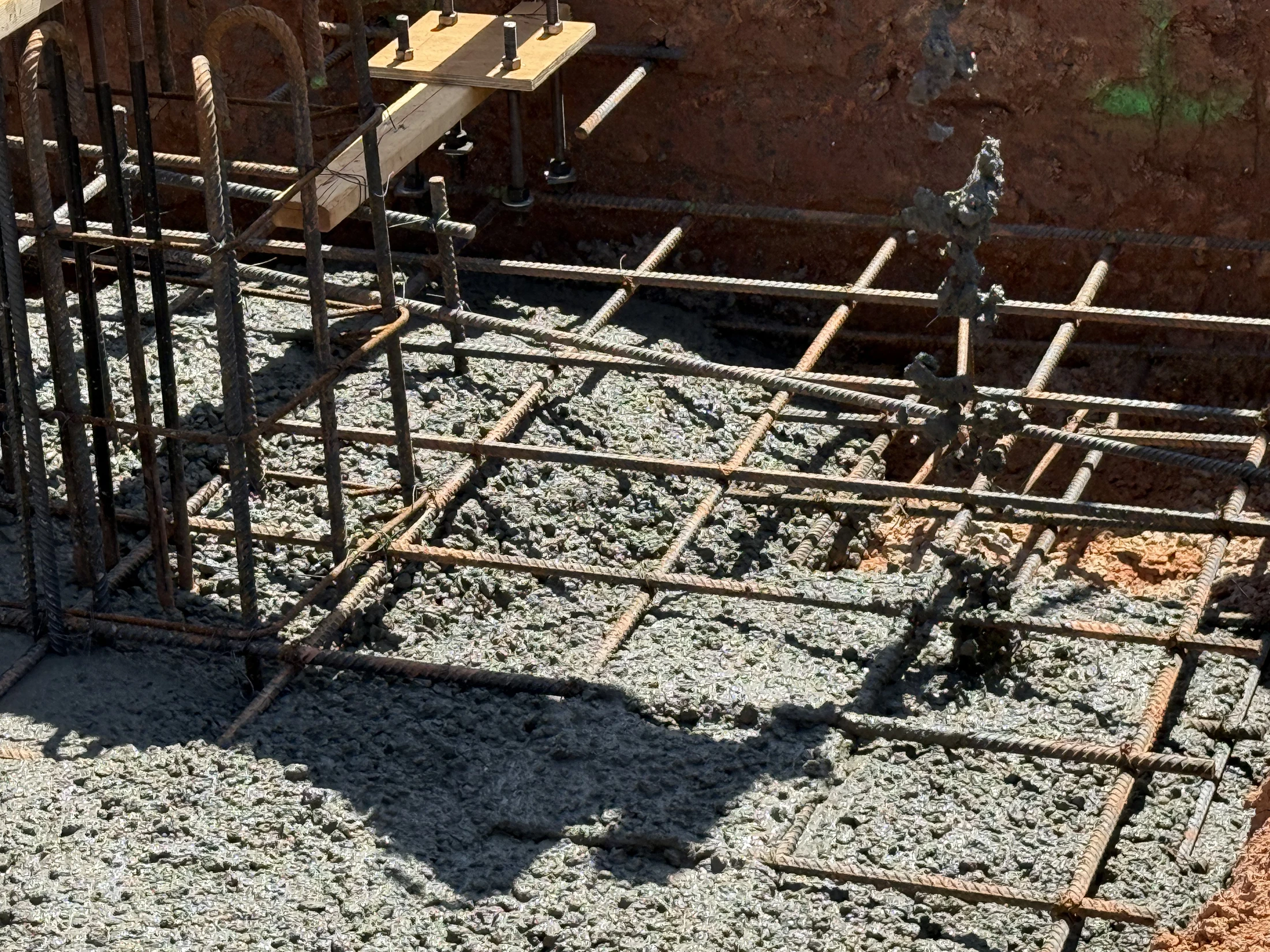

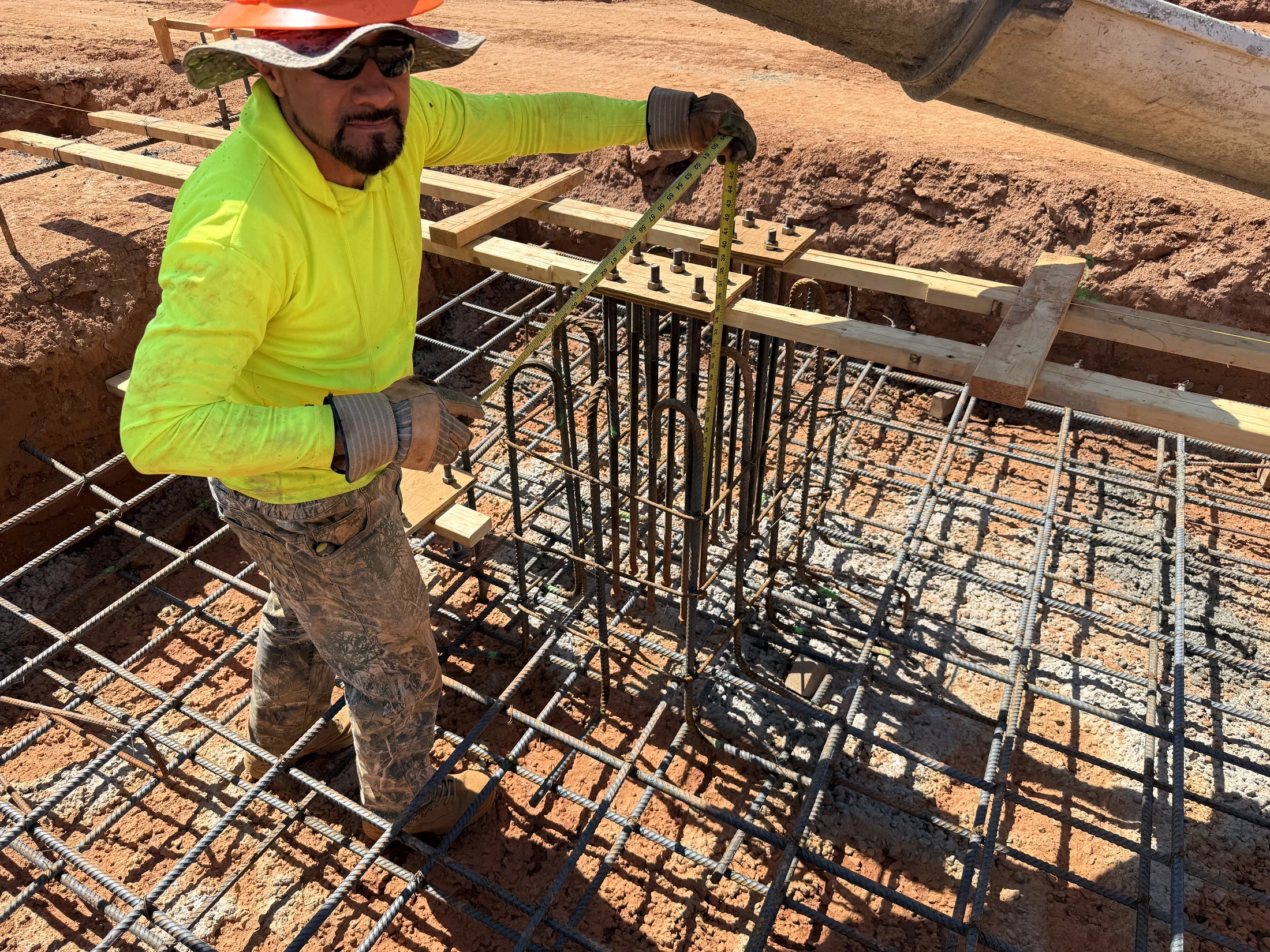

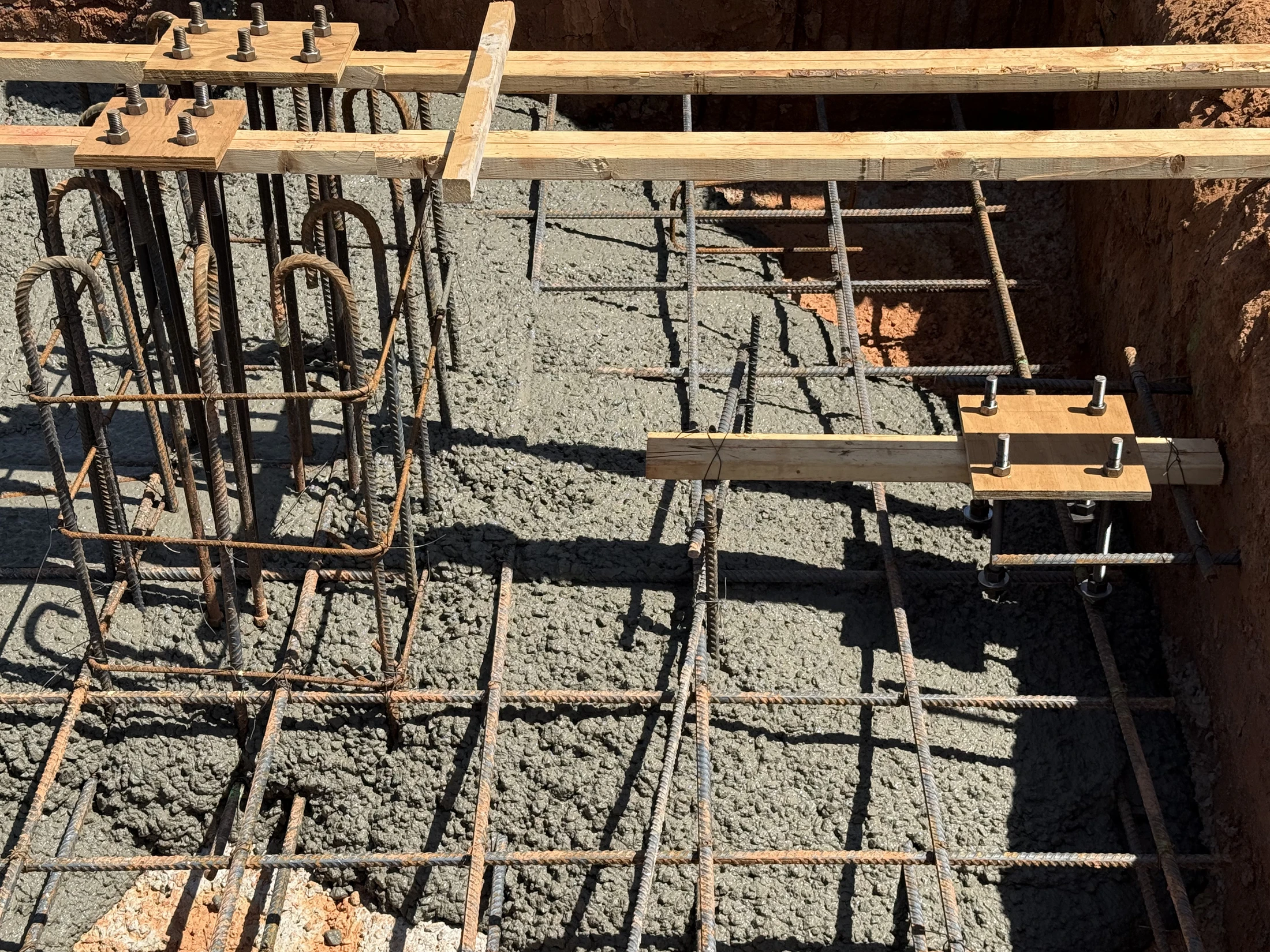

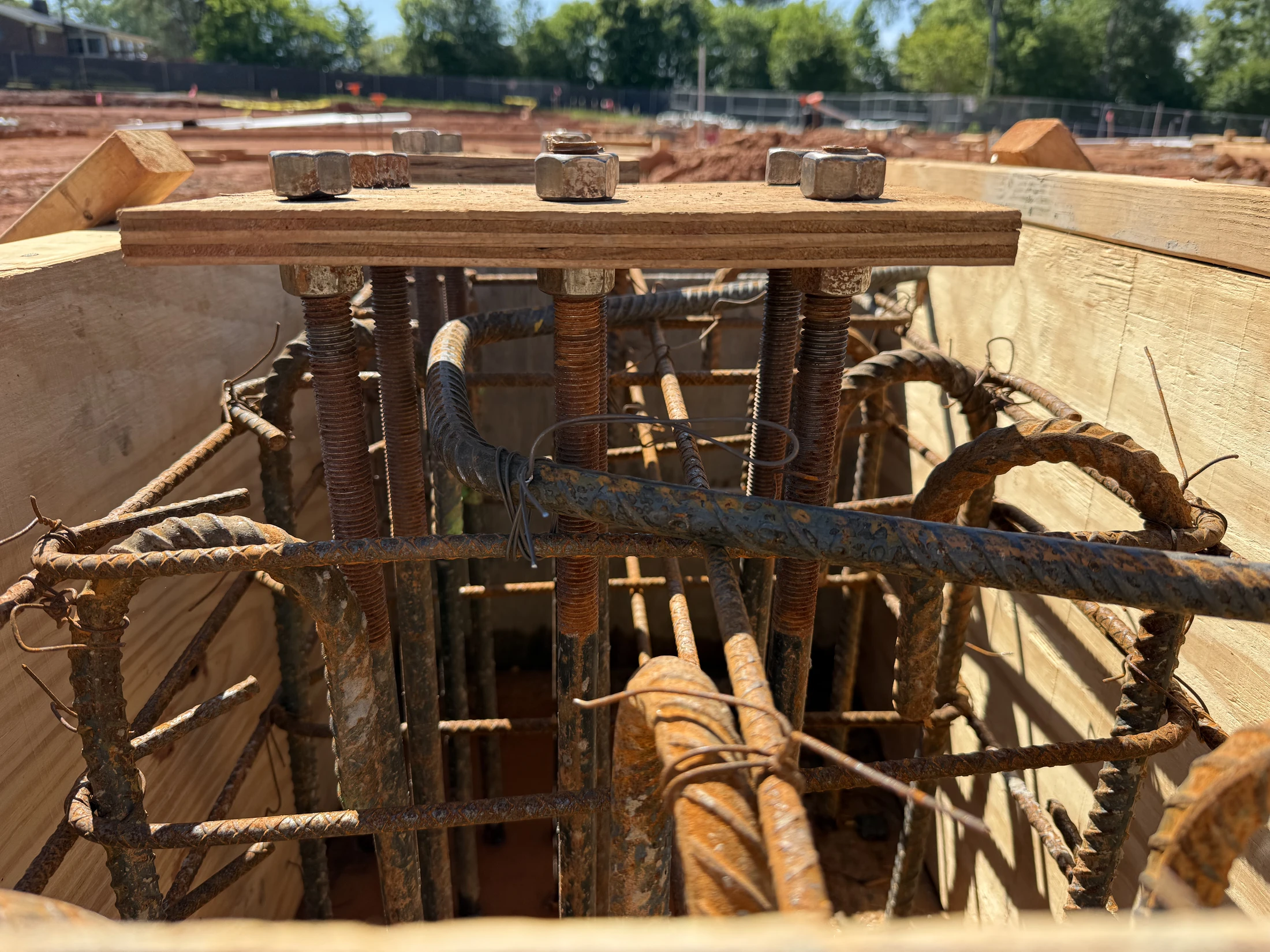

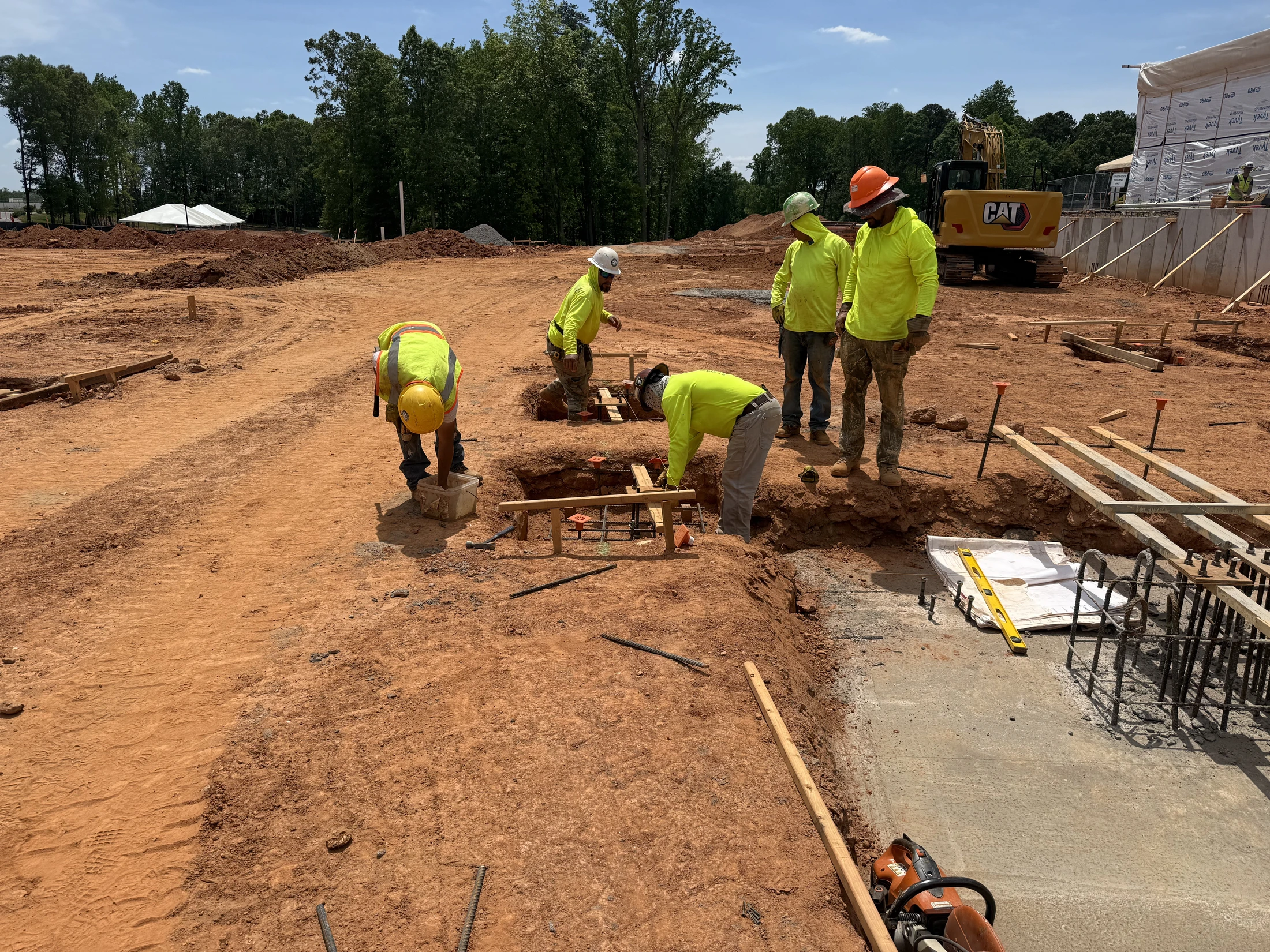

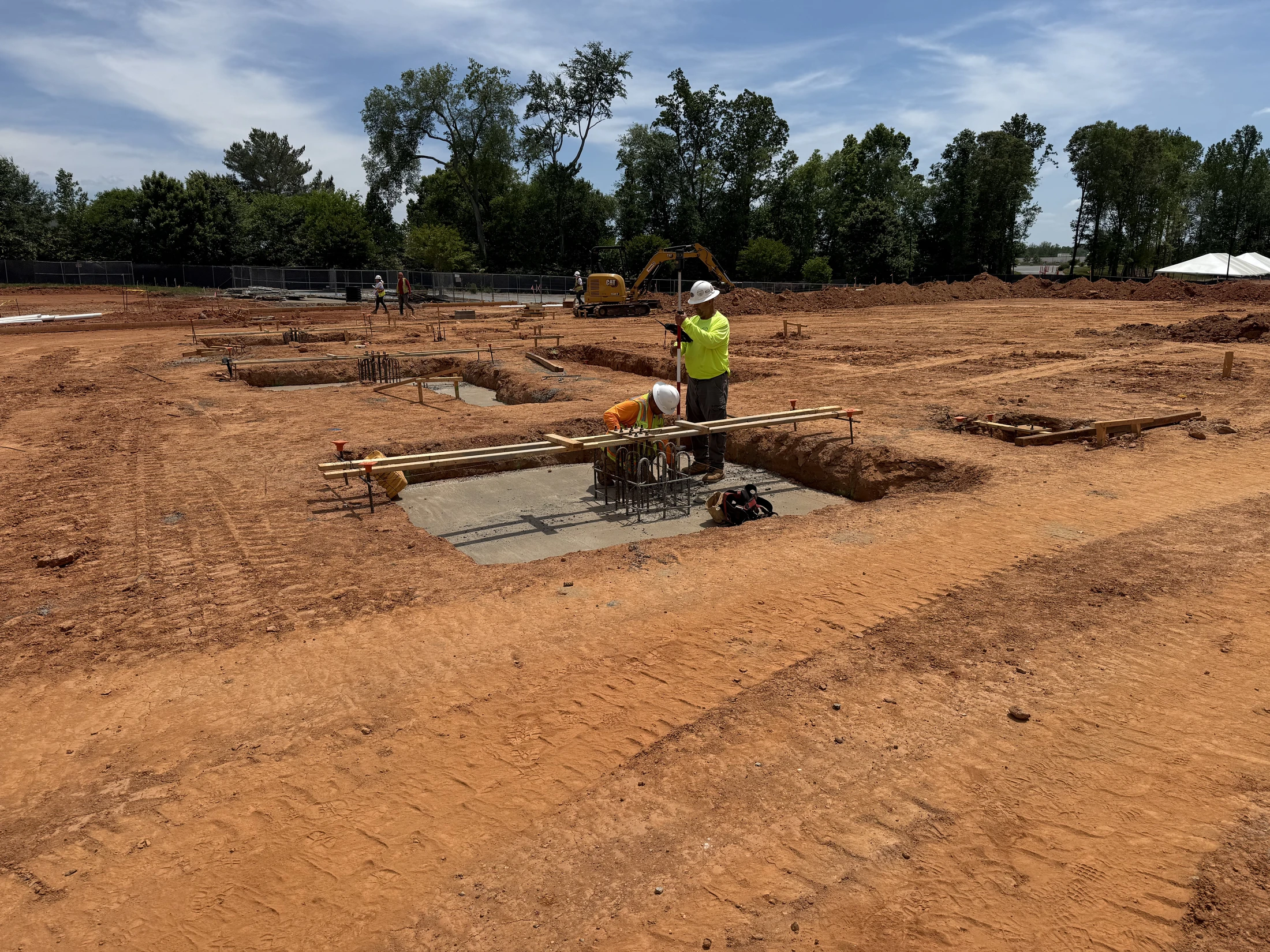

The concrete contractor installed anchor rods and poured main column footings on column line 11. (4 men)
The plumbing contractor began the under slab rough-in. (2 men)

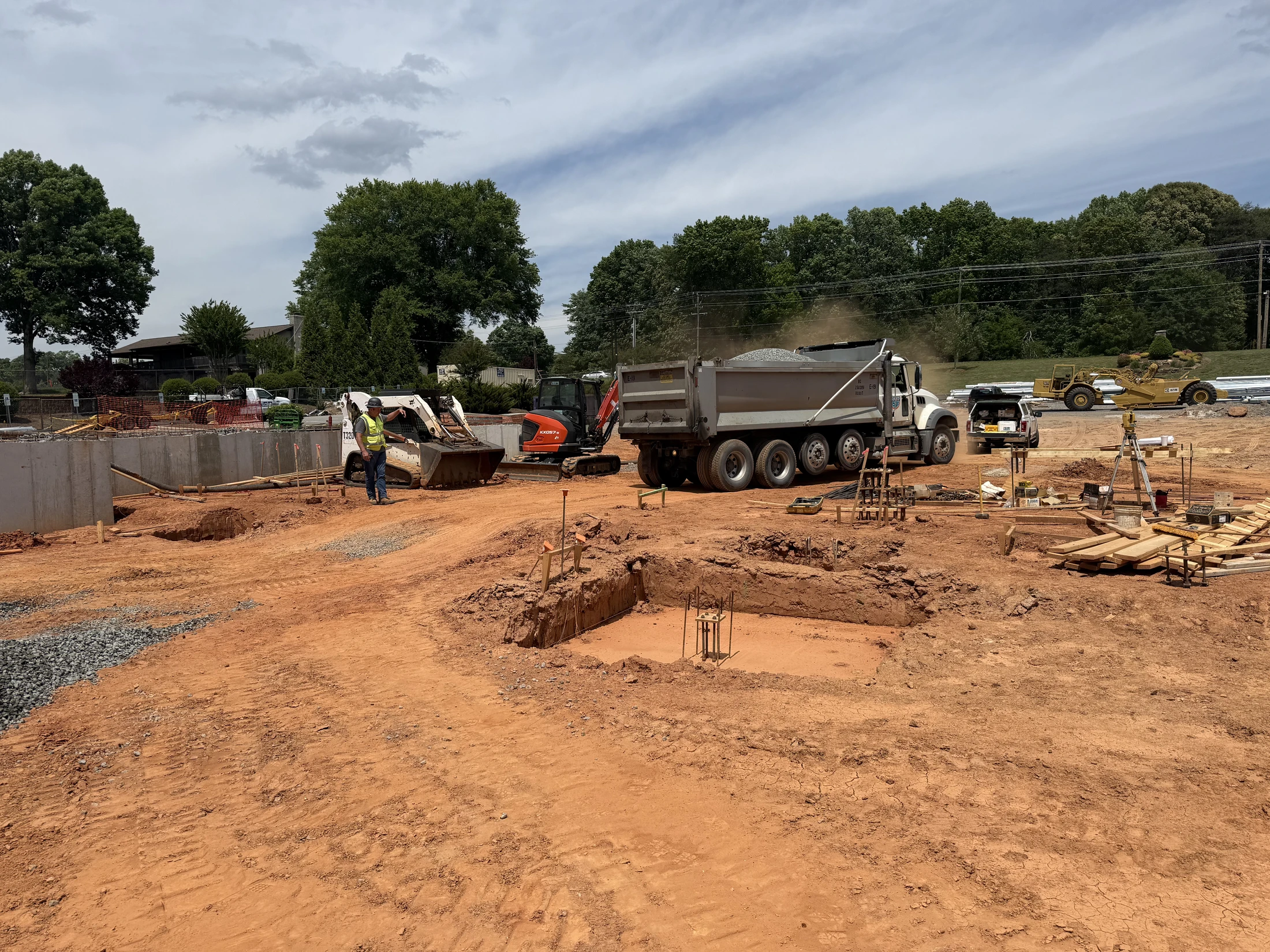

The concrete contractor poured footings for structural steel. They also braced retaining walls for backfill. (8 men)
The plumbing contractor continued with the under slab rough-in. (6 men).
The grading contractor began backfilling the retaining walls. (4 men)
The electrical contractor installed conduits under the slab in building “B”.
Partial under slab inspections were performed for plumbing and electrical rough-ins. Trenches for plumbing and electrical were backfilled.
The grading contractor completed backfilling walls.
The concrete contractor constructed column pier forms and installed rebar.
Rain began around noon and continued for about an hour. Most work ended except for the electrician working on the wiring layout.
1/4 “of rain fell overnight with more expected throughout the day. Rain total was 1/2 “.
The building inspector came by the job site to discuss the slope on rear stairs and sidewalk. He confirmed that what is designed is acceptable with proper markings.
The electrical contractor was on-site doing the layout for electrical and AVL conduits. (2 men)
The concrete contractor dug footings for the masonry firewall, installed the rebar and poured.
