Building Project Update for 7/08/2026
Project Schedule
Key Dates
8/15/2026: Existing construction entrance moves to the rear of the building and Children's addition (Building C) grading, concrete, utilities, steel, and framing are underway as well as demo, utilities, framing in the existing front area of the offices and children's areas. Duration 12 weeks.

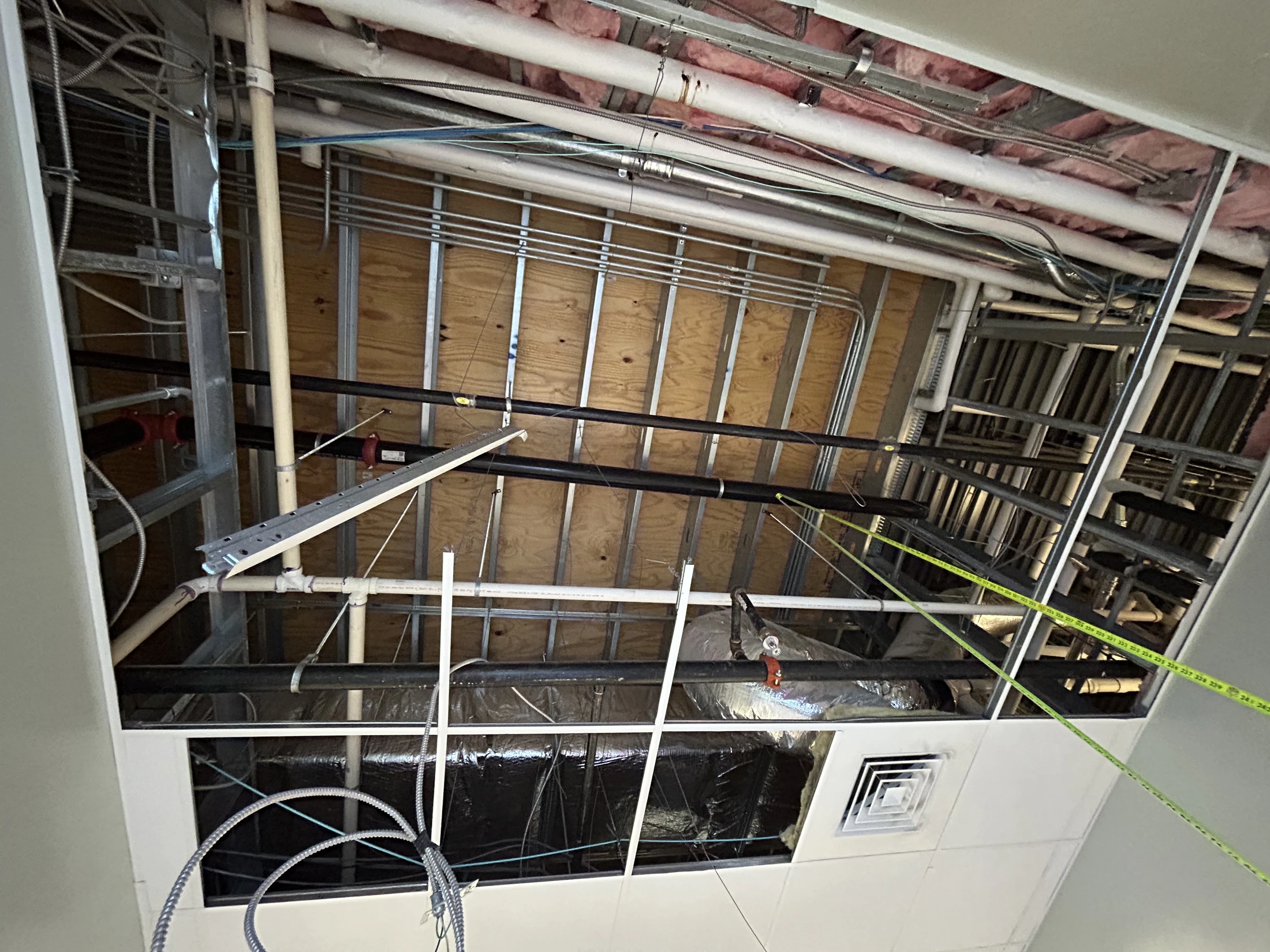

8/15/2026: Building A & B overhead rough-in complete.
9/1/2026: Building A stadium seating framing complete.
10/15/2026: Building A & B wall rough-in complete.

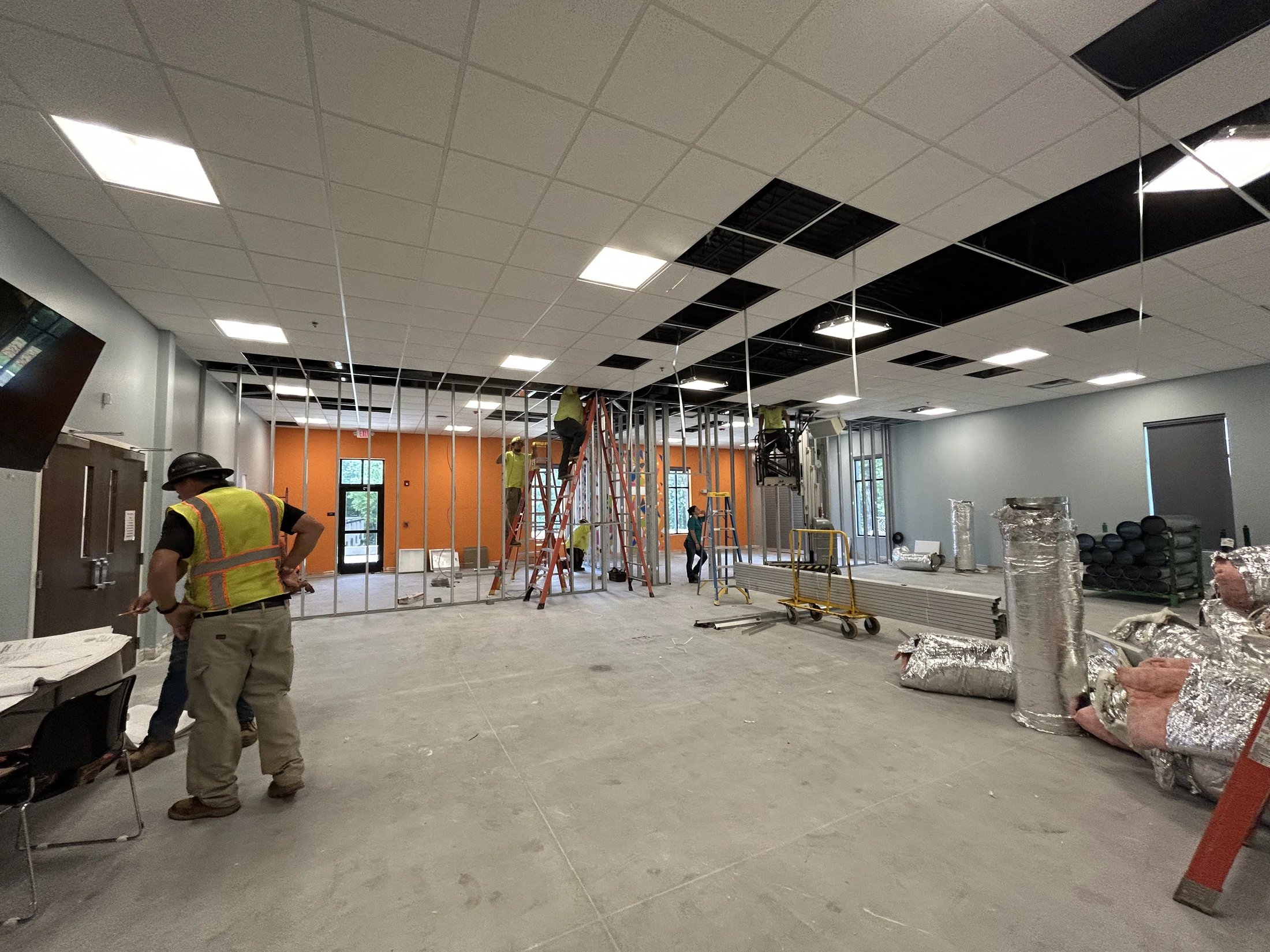

10/31/2026: Building A & B drywall hanging complete.

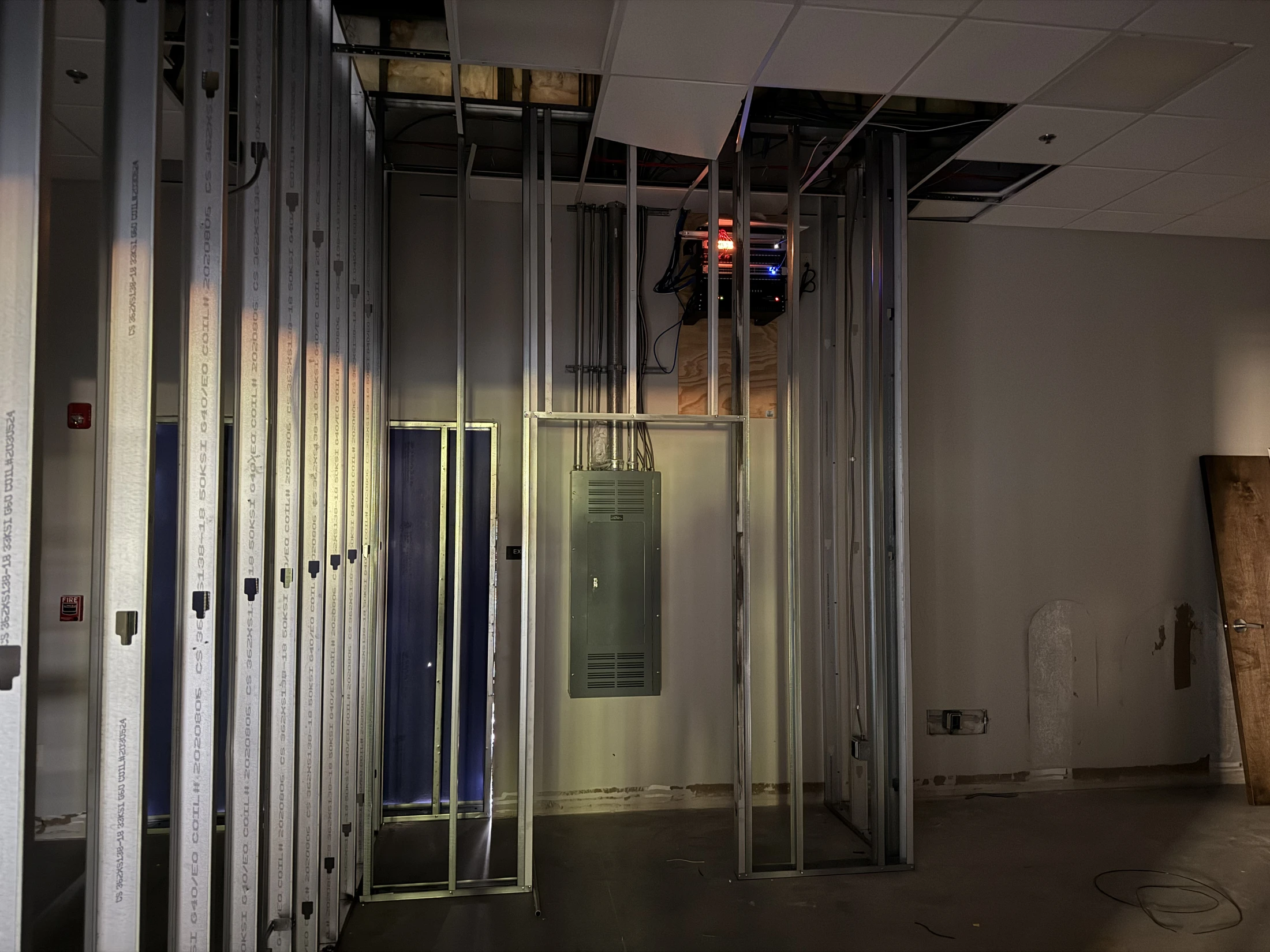

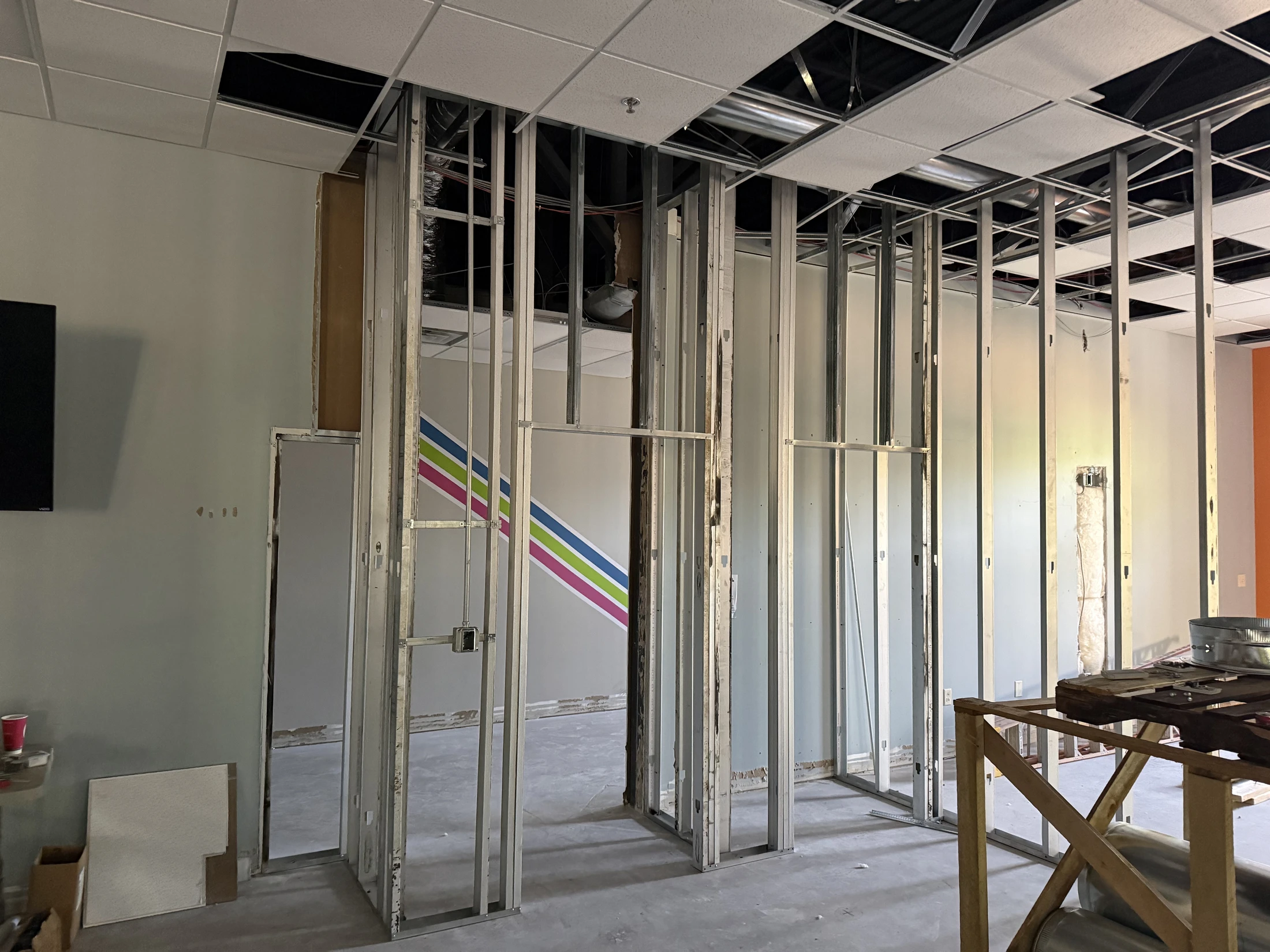

11/15/2026: Entrance reverts to the old lobby double doors (where it stays for the duration) and feeds thru a tunnel to the side area where the current construction entrance is located. Work continues in all areas of the building with the exception of the existing sanctuary.
Current Activity
Last Week's Activity
6/29/2026 through 7/03/2026

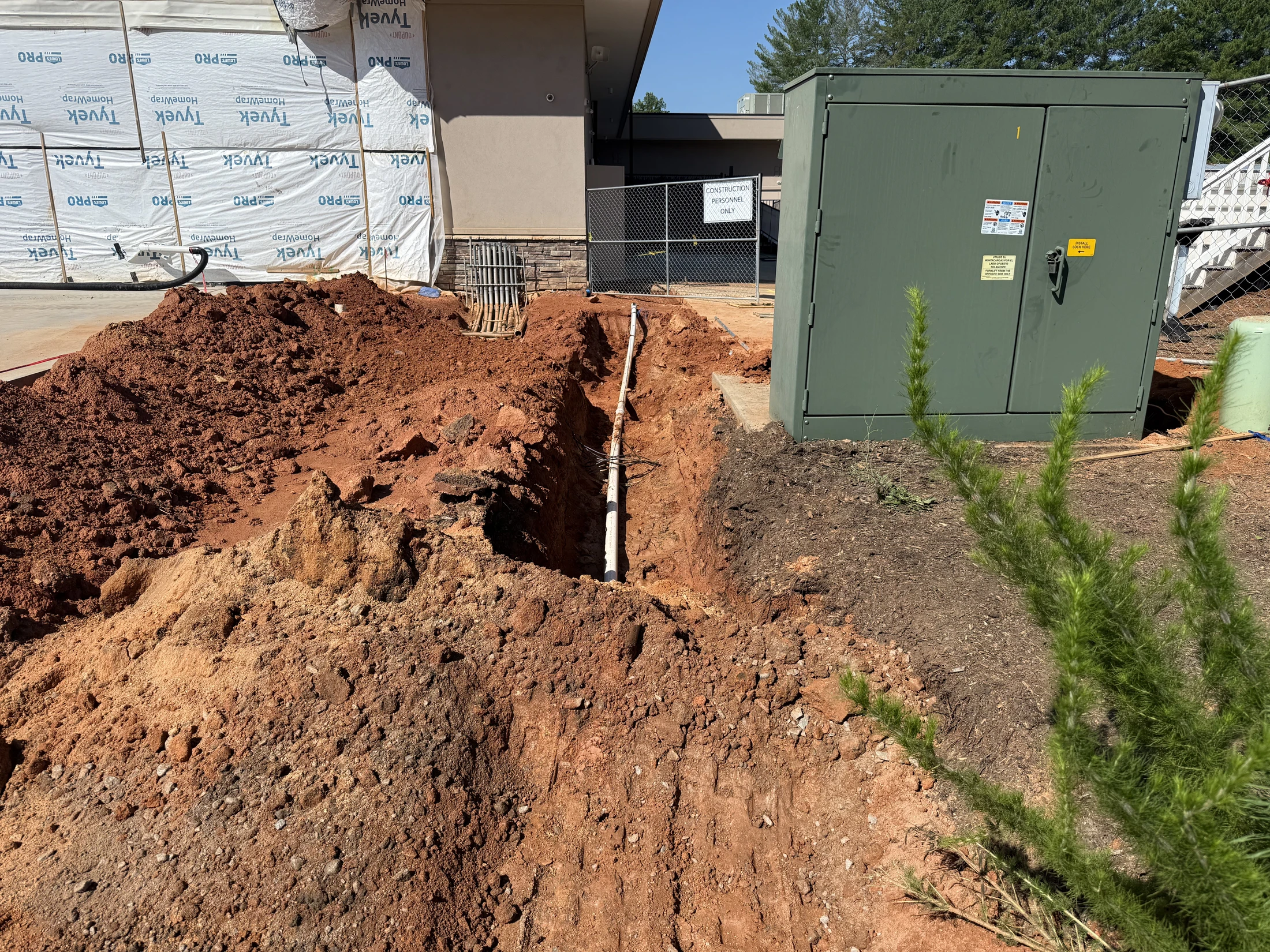

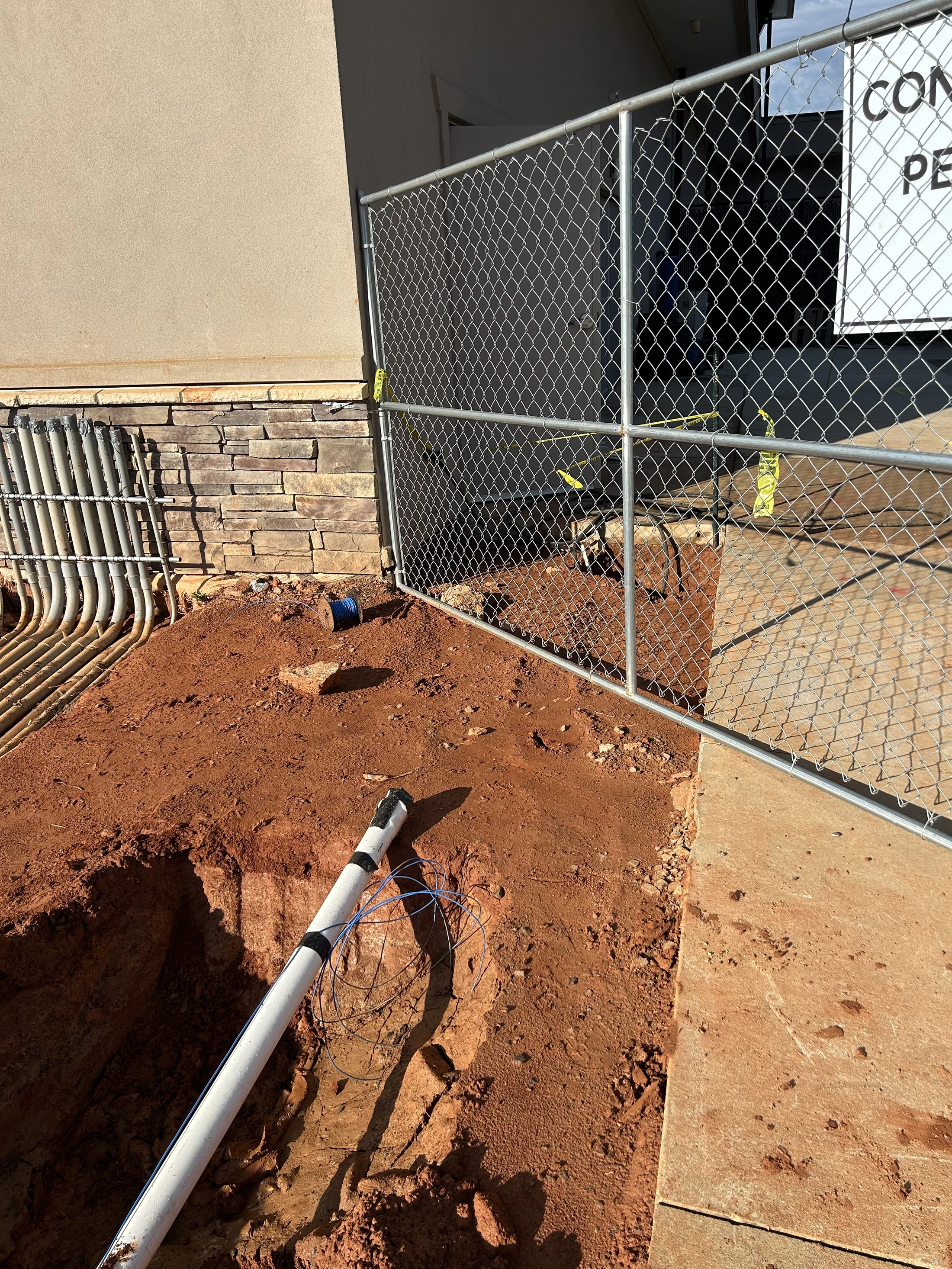

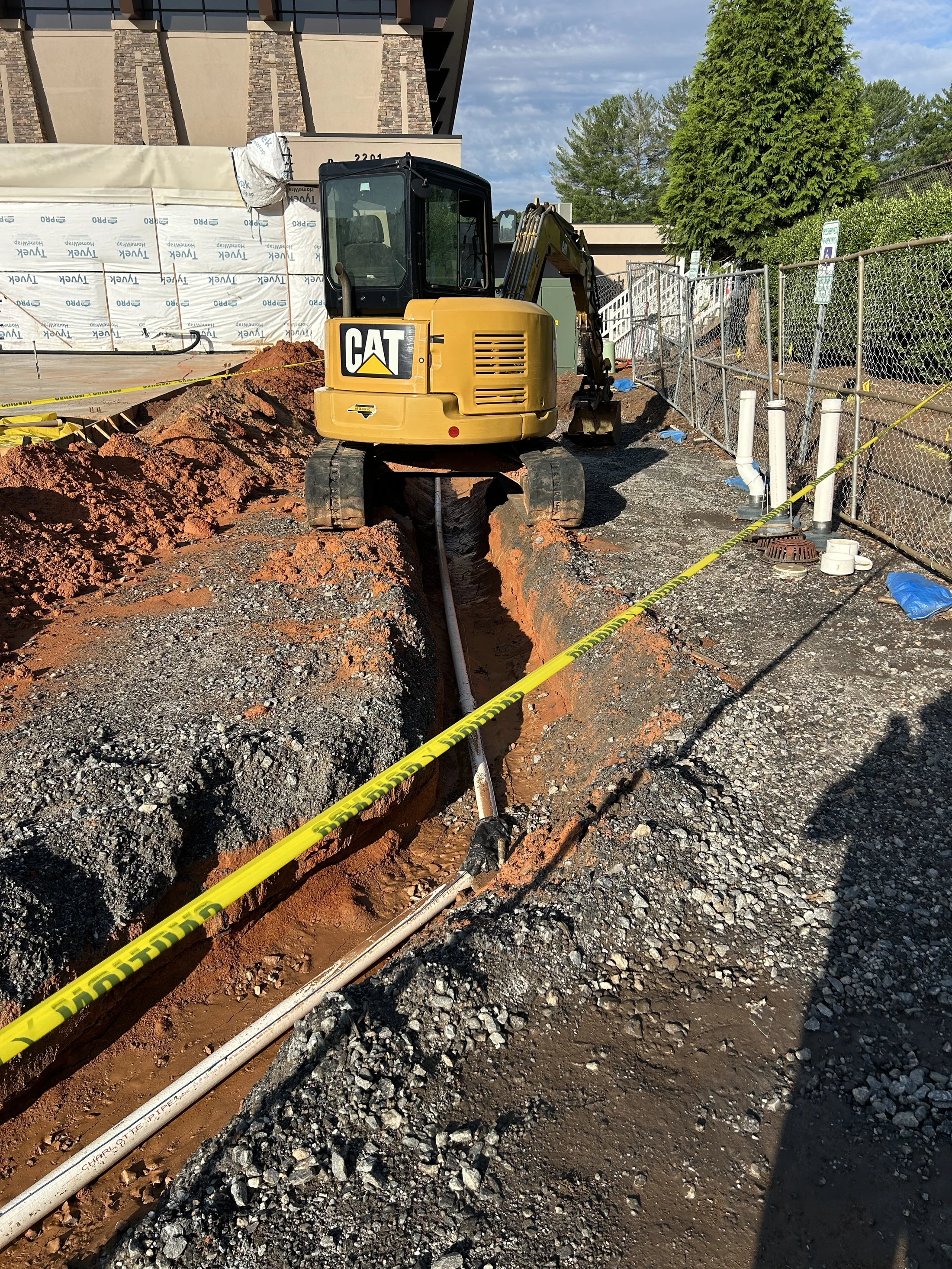

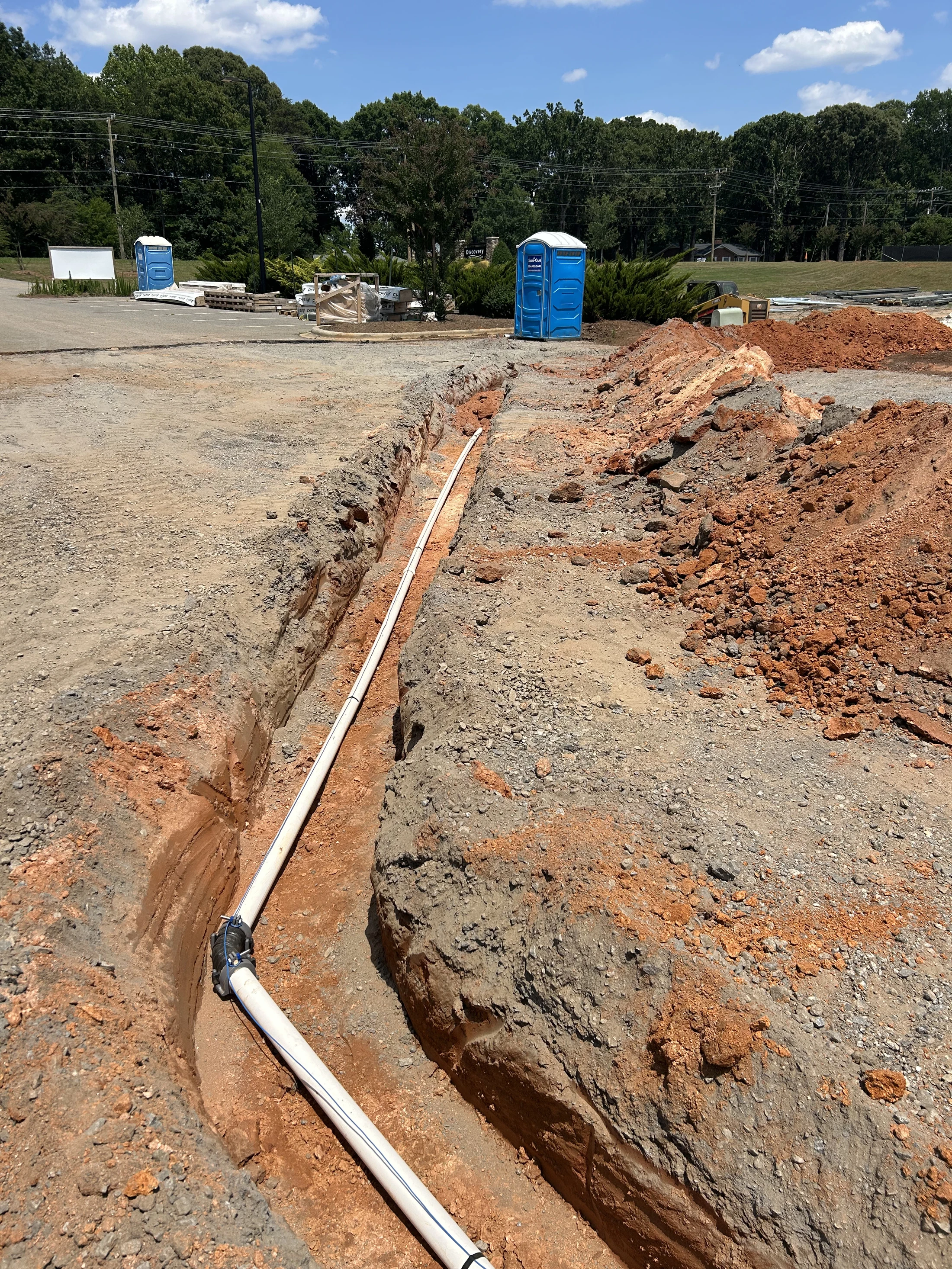

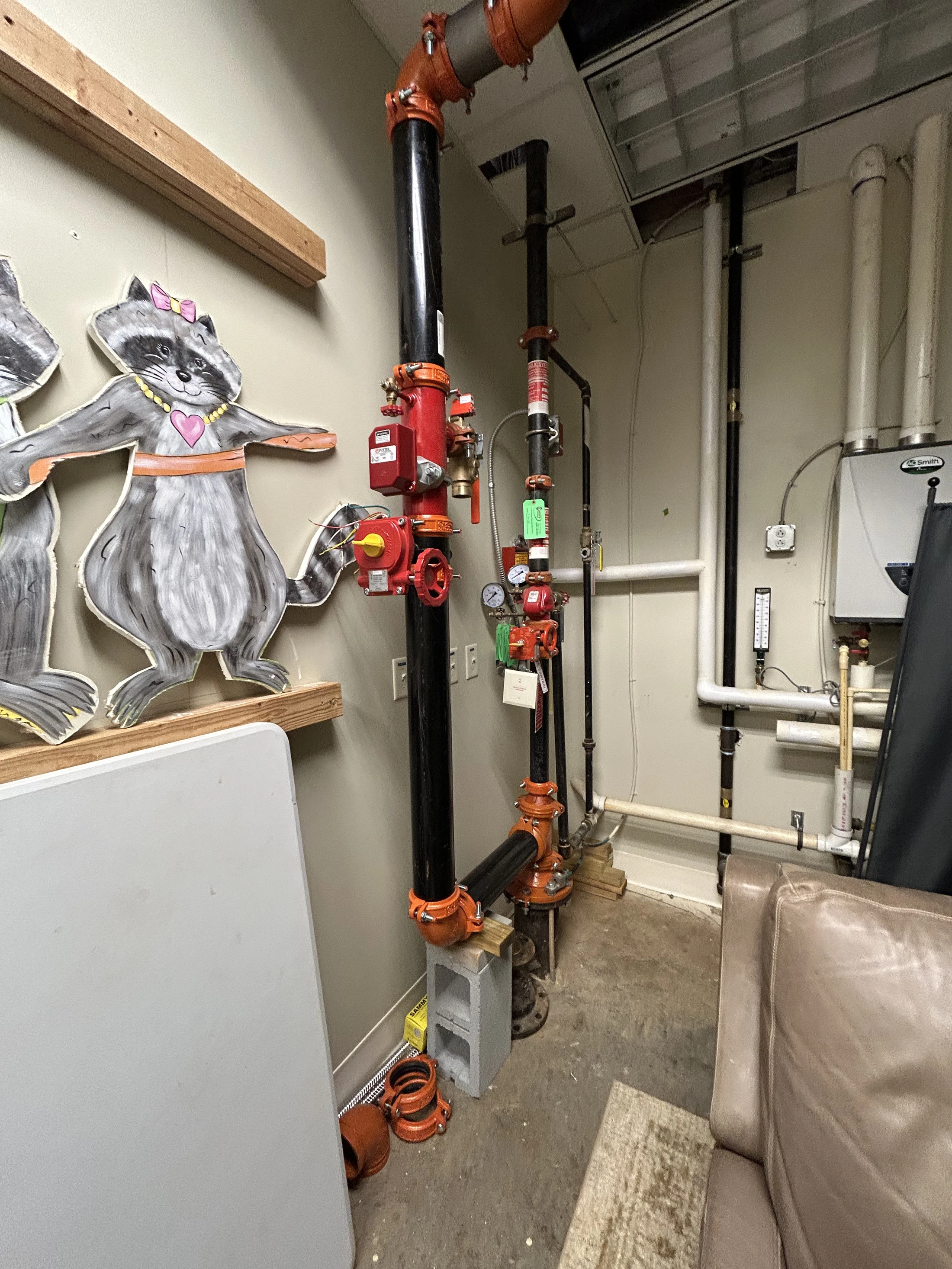

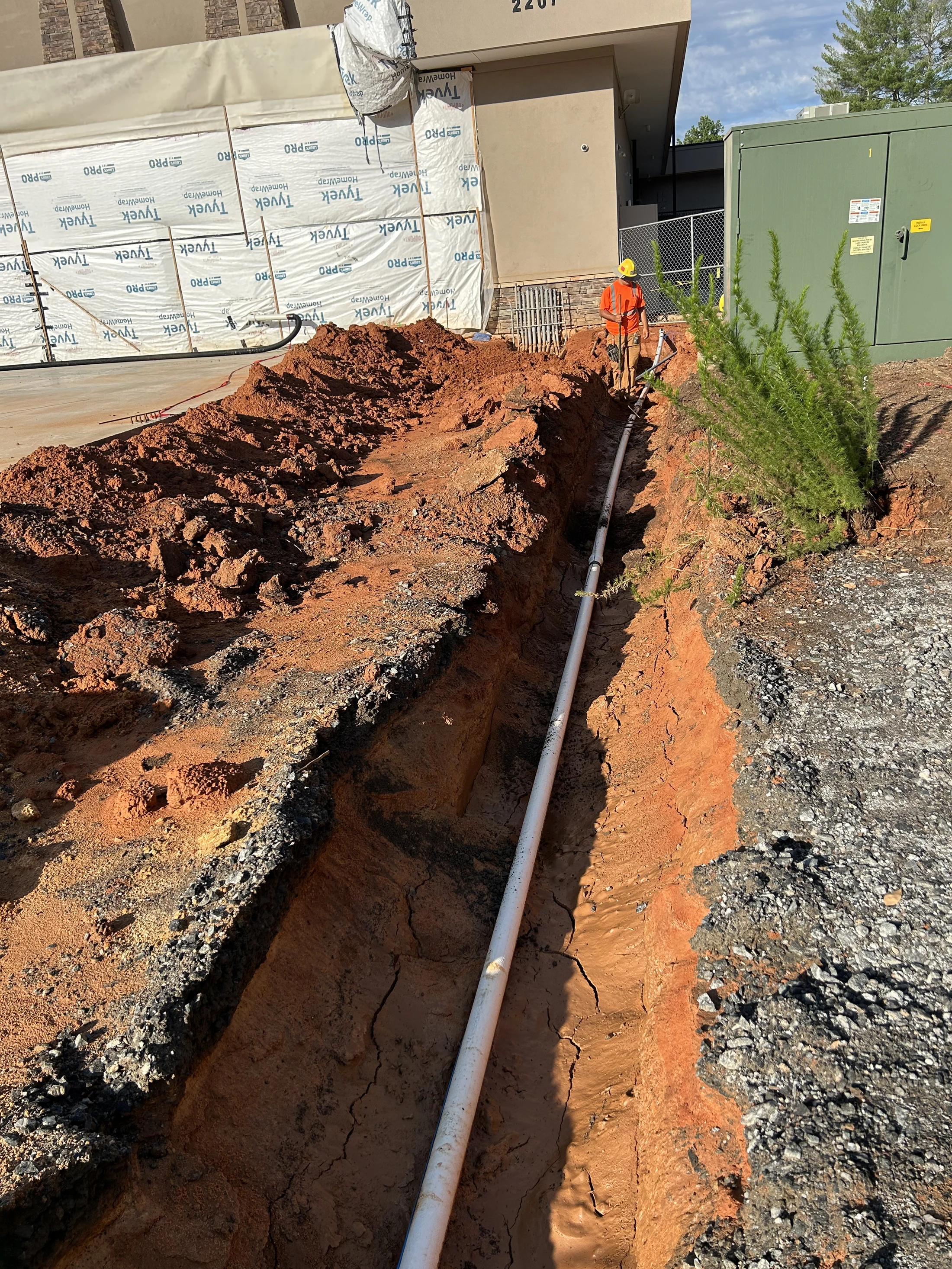

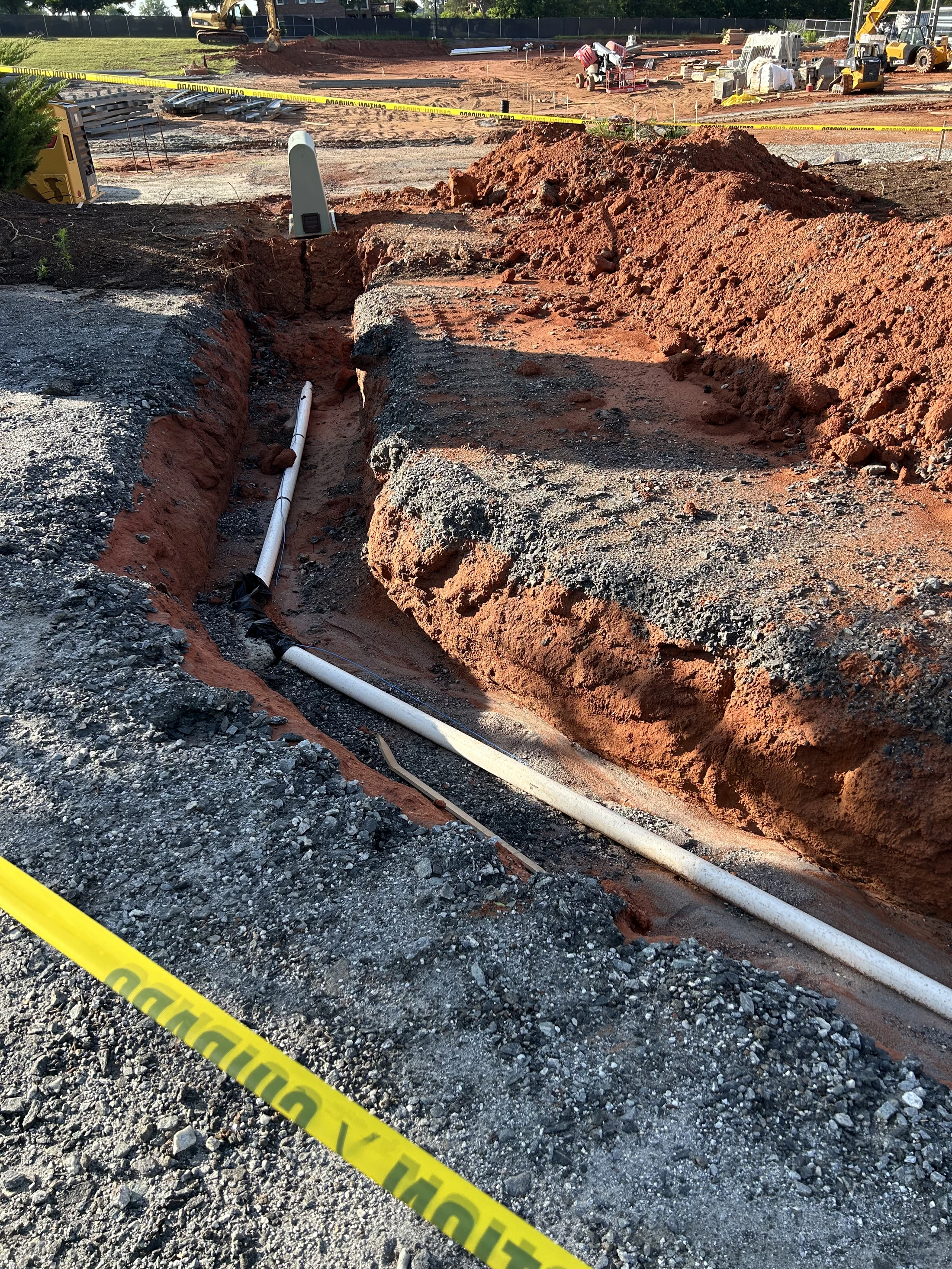

Primary Electrical and Water Feeds

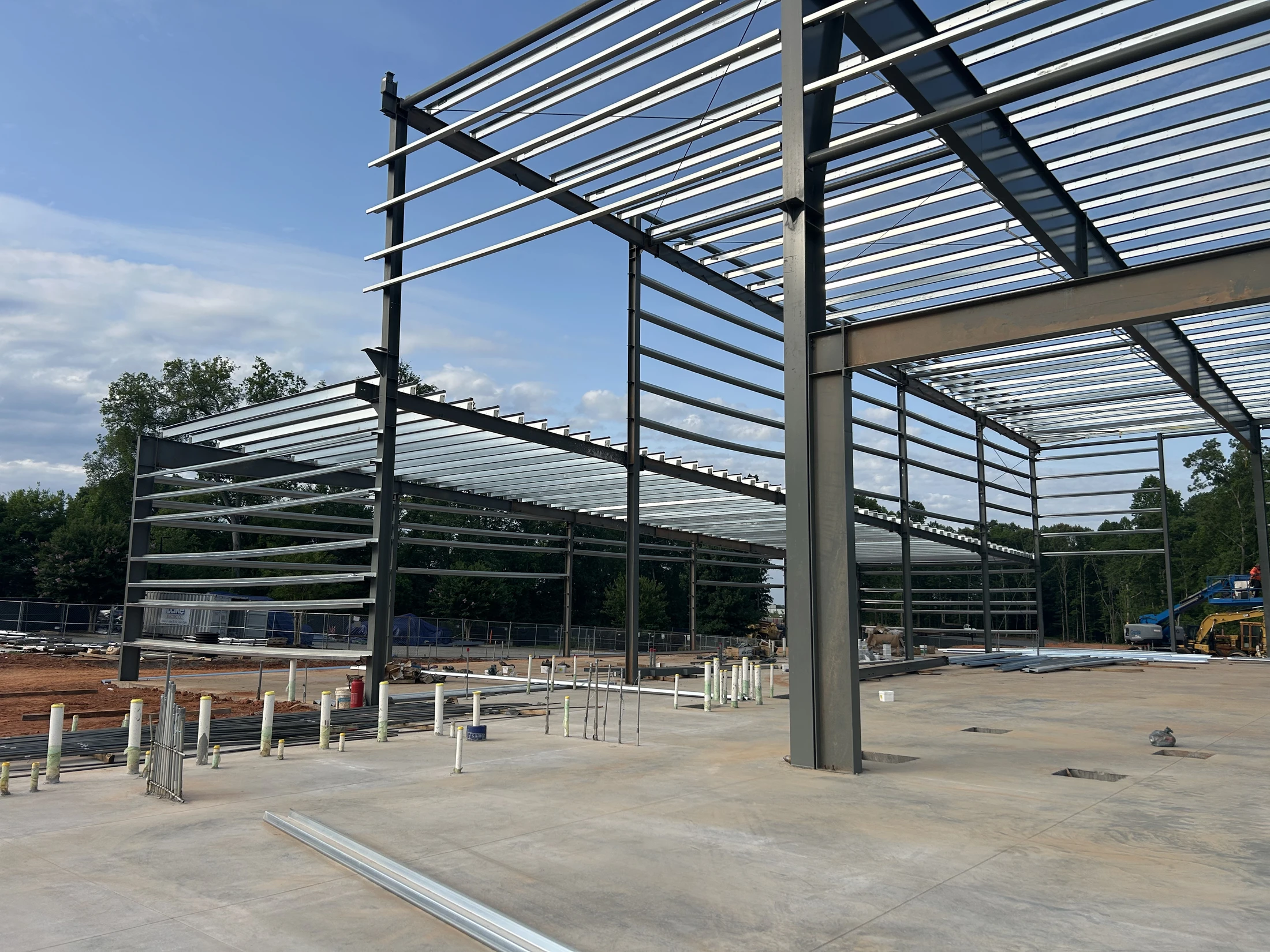

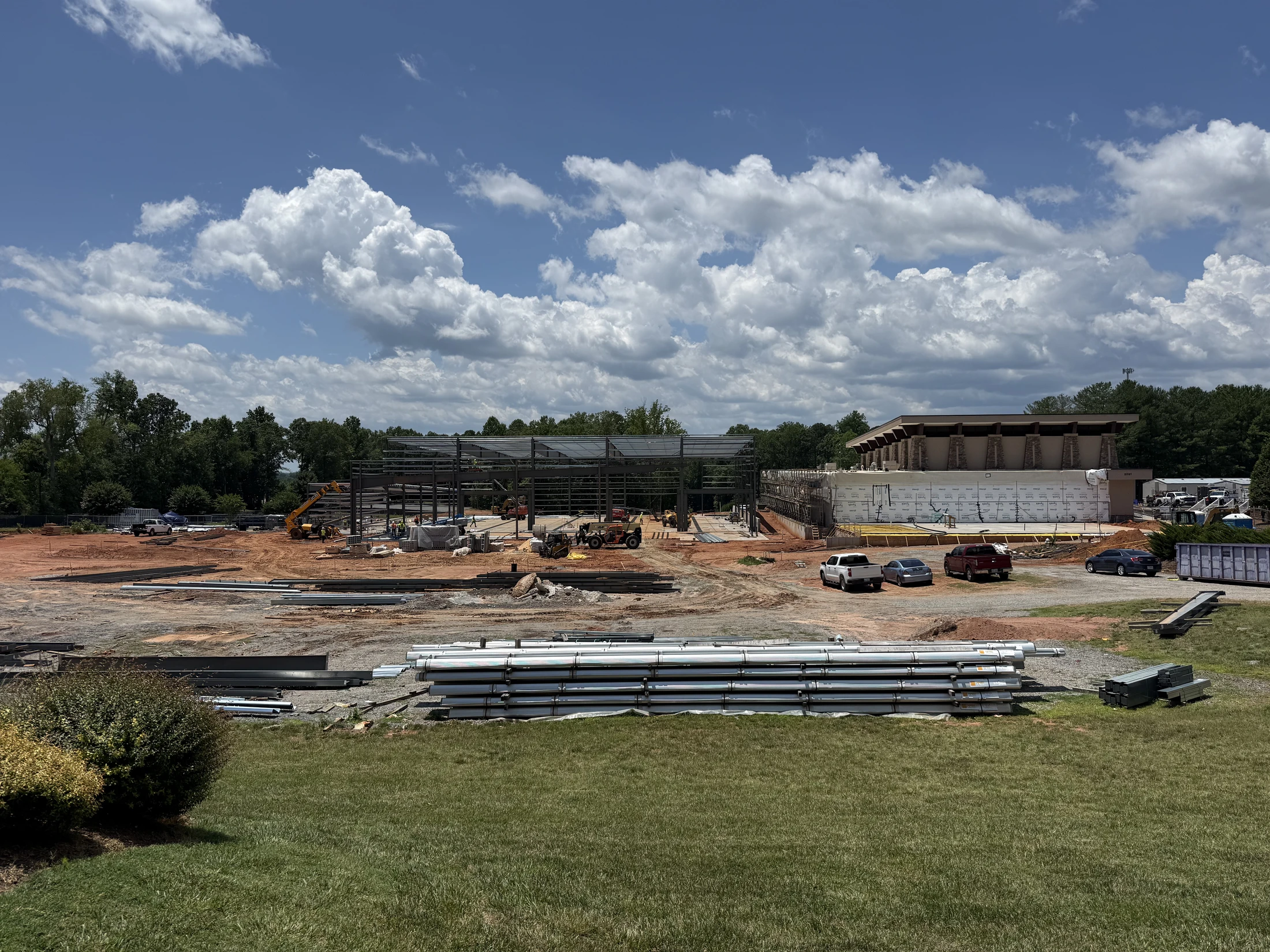

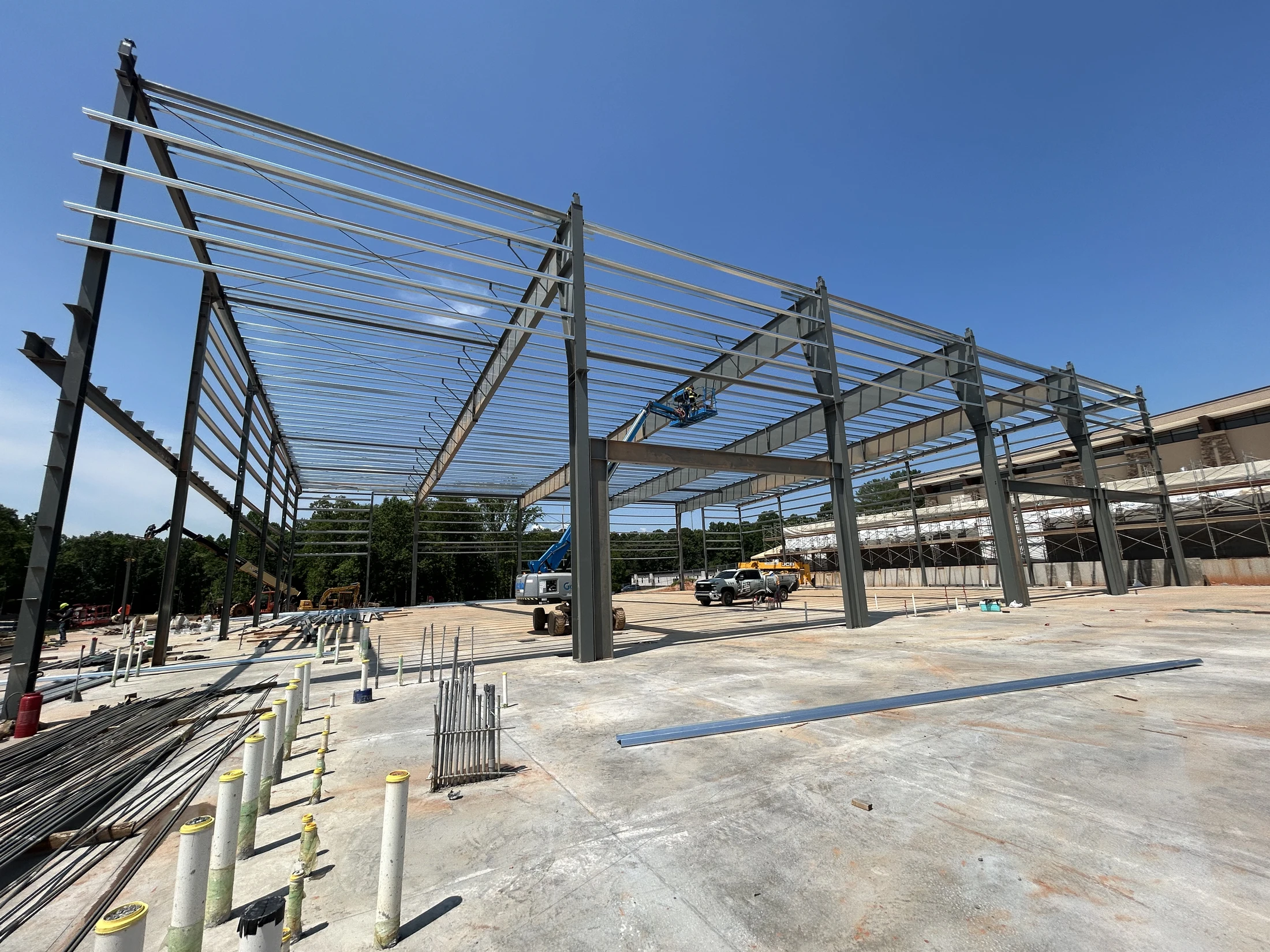

Steel Erection

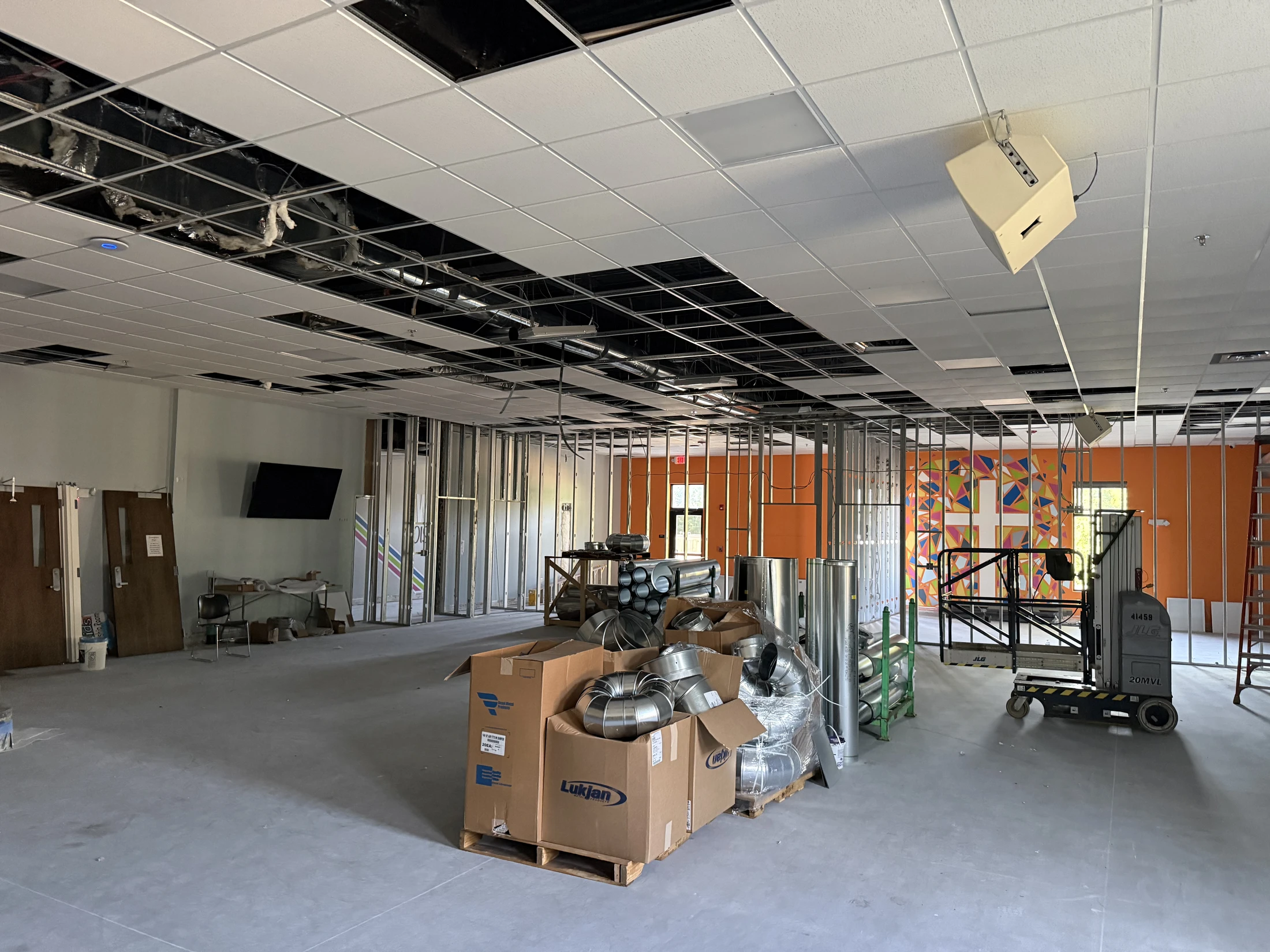

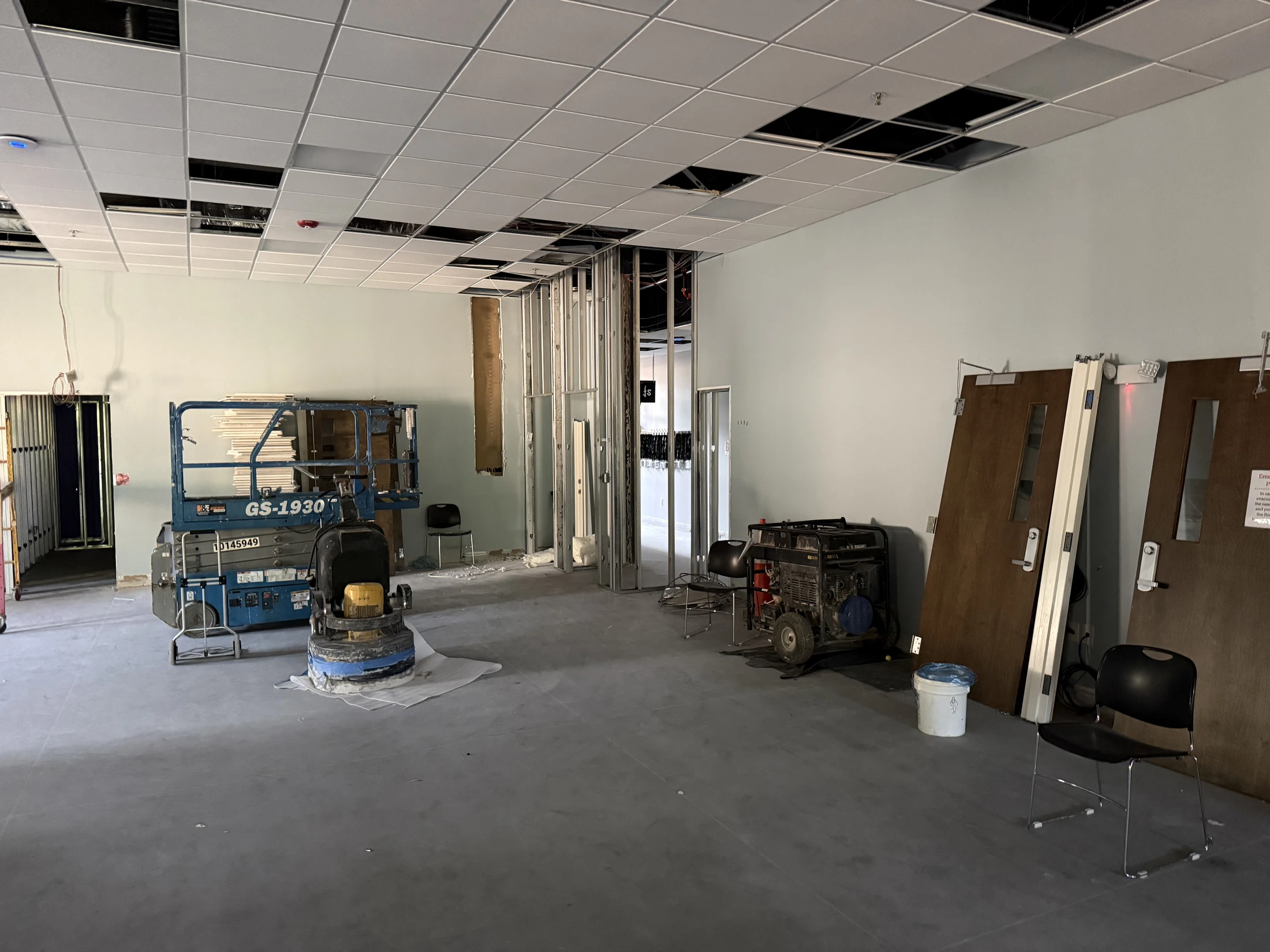

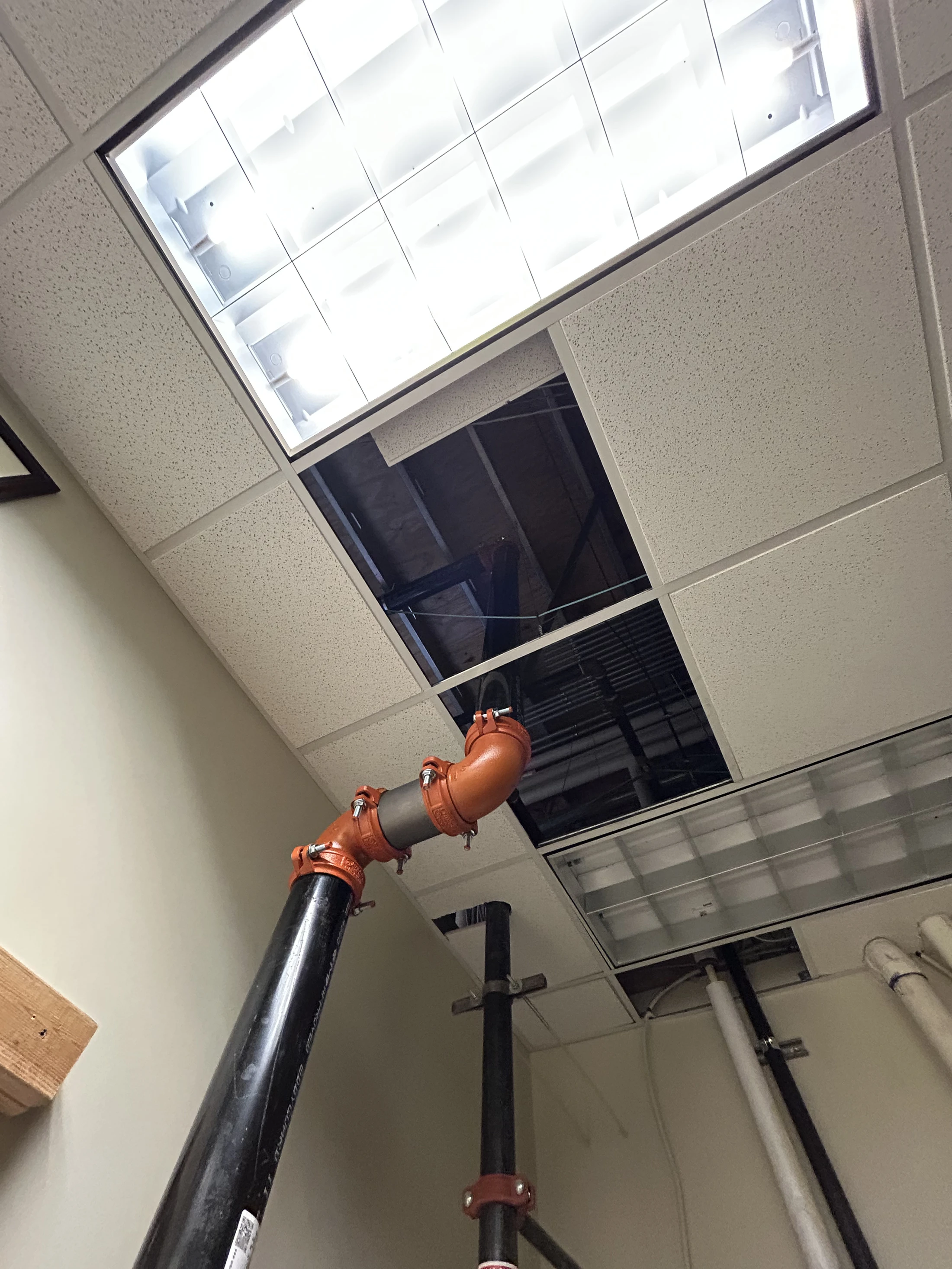

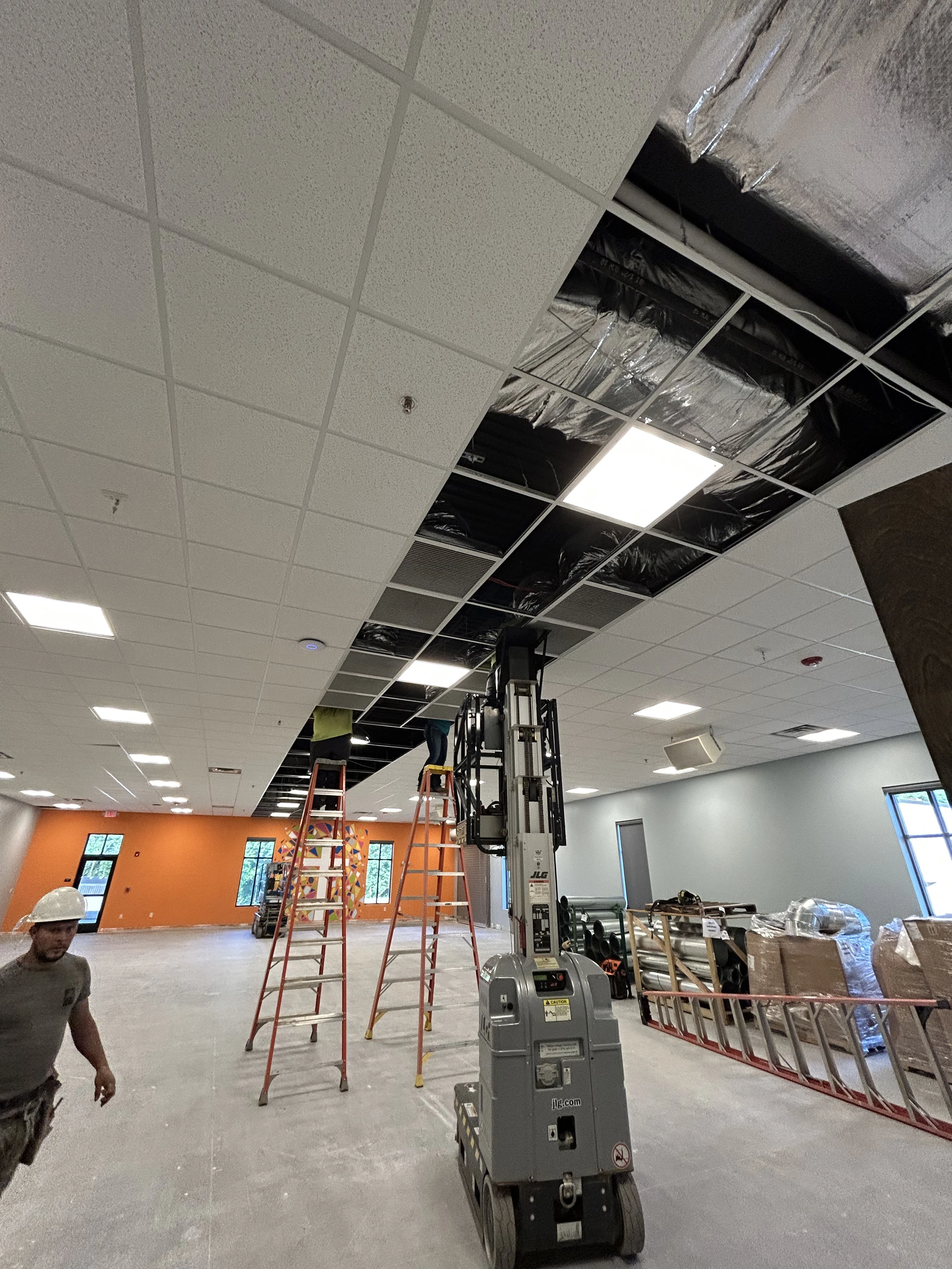

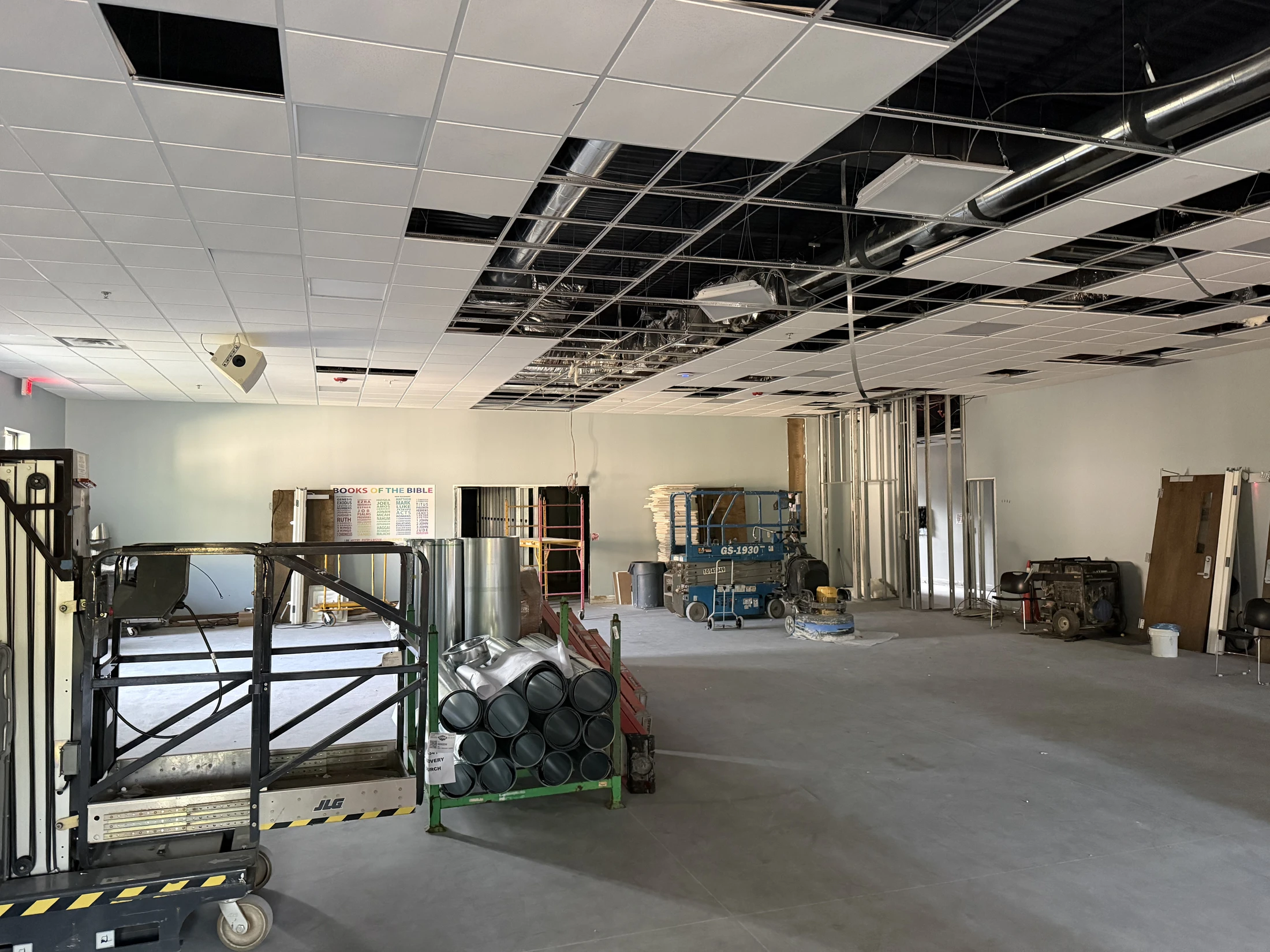

Kid's Expansion Remodel
